Evergreen House at dusk: a nine-storey residence with deep bay windows lit from within, bronze fins on the corner

Kanak Constructions presents

Evergreen House

Twenty-one 1 and 2 bedroom homes over three shops on Owali Road, Kamatghar: three to a floor around a central lift and stair, rising above a quiet street.

Now under constructionOwali Road, Kamatghar, Bhiwandi

Artist's impression · dusk, west elevation

Configurations
1 & 2 BHK
Floors
Ground + 7
Homes · Shops
21 · 3
RERA carpet
333 – 392 sq ft
Possession
tbc
RERA no.
tbc

Built around light,
not around a plan.

Every residence at Evergreen House sits in a frame of its own. The deep stone reveals hold each bay window out from the façade, so morning light reaches the back of the living room and the afternoon sun is cut before it arrives.

The bronze-toned fins on the corner do more than mark the entrance. They shade the stair and lift lobby on the hottest face of the building, and they give the street a single, unmistakable line to remember the house by. Below, the ground floor is given over to a small retail frontage and a stepped entrance, keeping every home above the noise of the street.

  1. 1Three homes to a floor around a central lift and staircase lobby, on every floor from the first to the seventh
  2. 2Every home has its own living room, kitchen and toilet; the 2 BHK adds a second bedroom, a bath and a separate WC
  3. 3Three shops with rolling shutters on the street, the entrance lobby beside them
  4. 4Two car bays and bike parking on the ground floor; lift to every floor
Evergreen House in late afternoon light, the bay windows held out from the façade in deep stone reveals
Golden hour · the bay windows, held out from the wall
The corner of Evergreen House with its bronze fins rising the full height of the building
The bronze fins on the corner

As proposedArtist's impressions from the architect's model. Stone reveals, bronze-toned fins and glazing shown as proposed; final materials and colours tbc

Sheet 01The residenceEvergreen House · Kanak ConstructionsArtist's impressions

The same street,
by day and at dusk.

Drag the line. The stone reveals that shade the rooms in the afternoon are the same ones that frame the light from inside at night.

Evergreen House in daylight
Evergreen House at dusk, windows lit
Golden hour Dusk

Drag the line, or tap anywhere on the picture.

Sheet 02Day to duskWest elevation, same cameraArtist's impressions

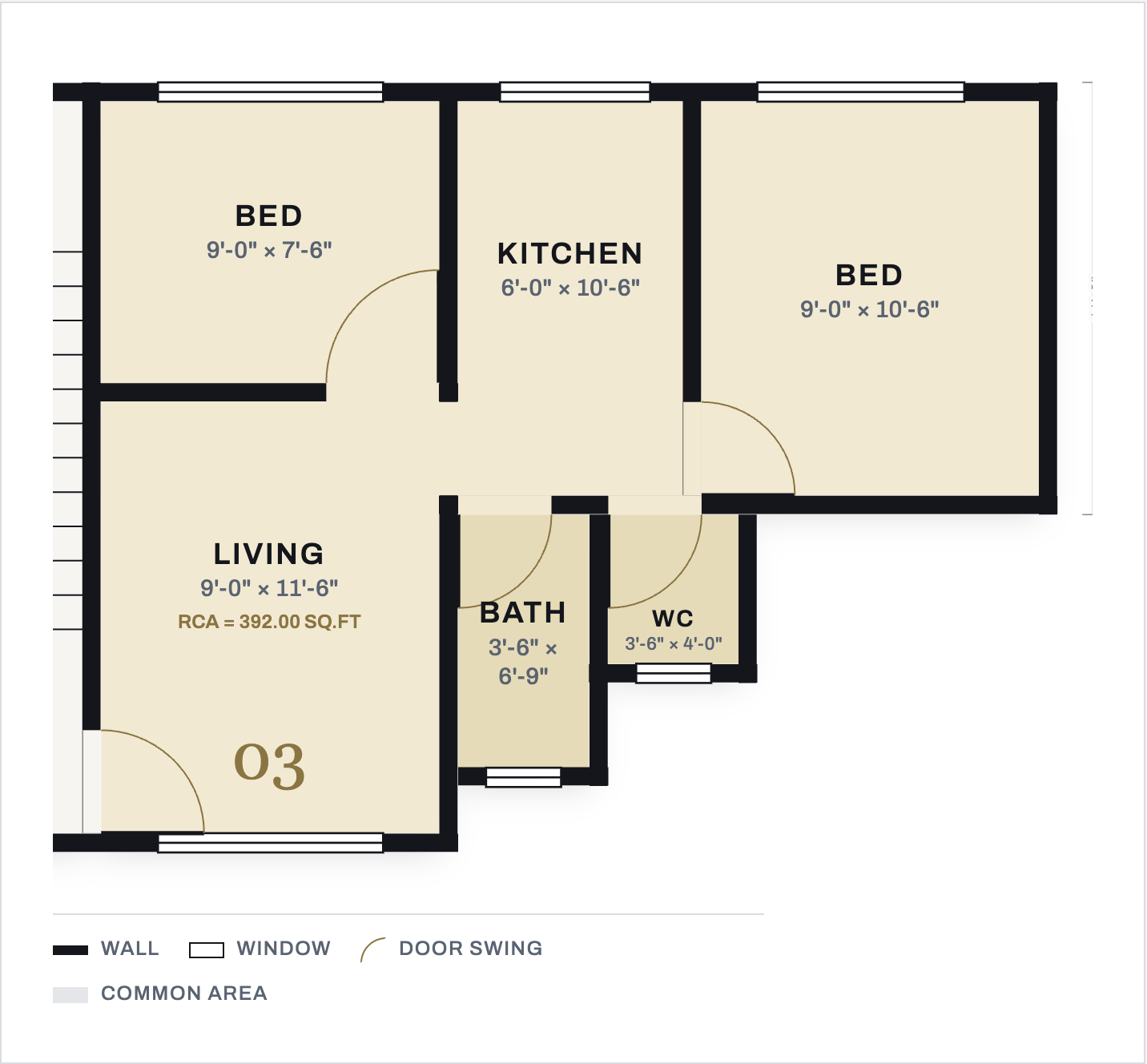

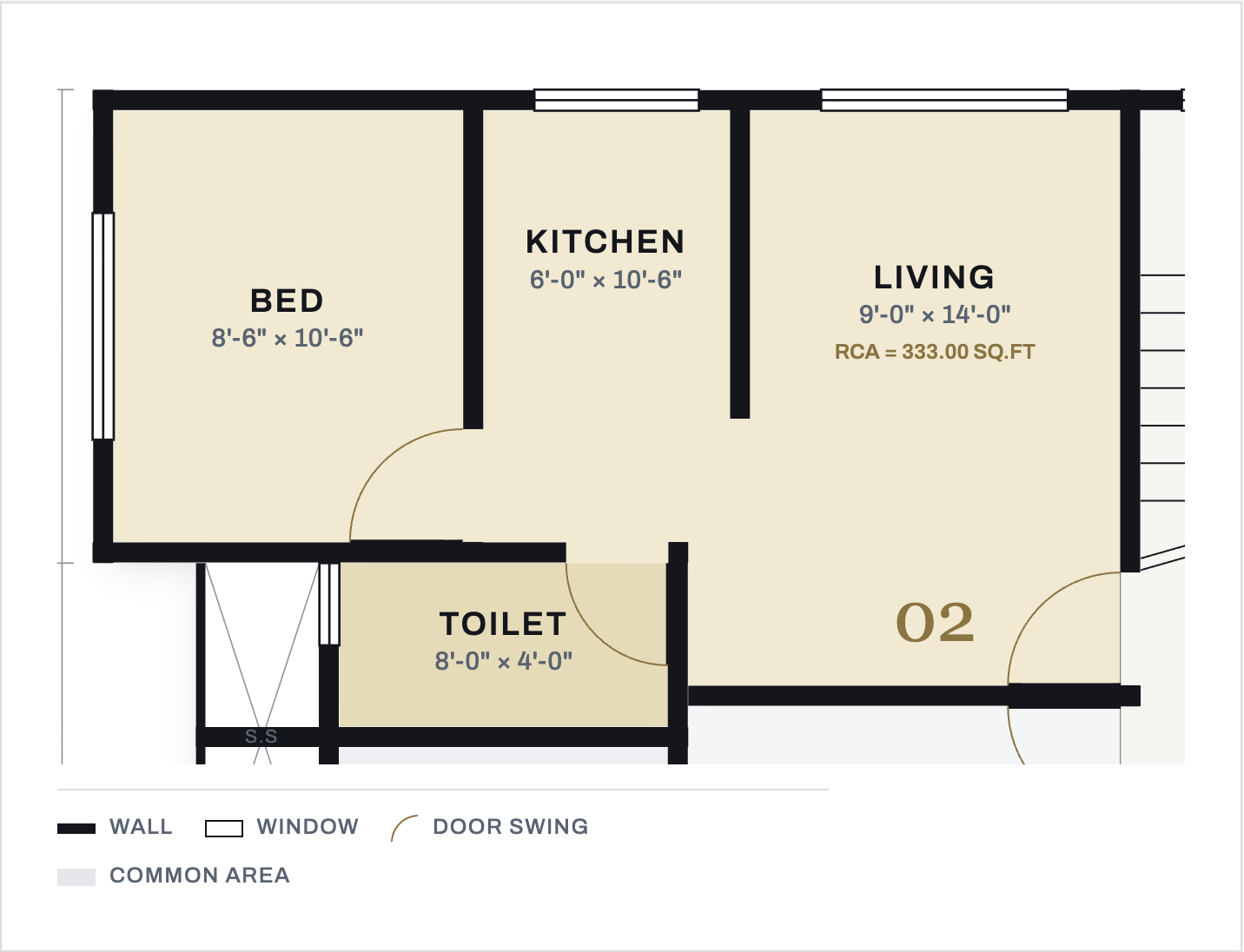

Floor plans

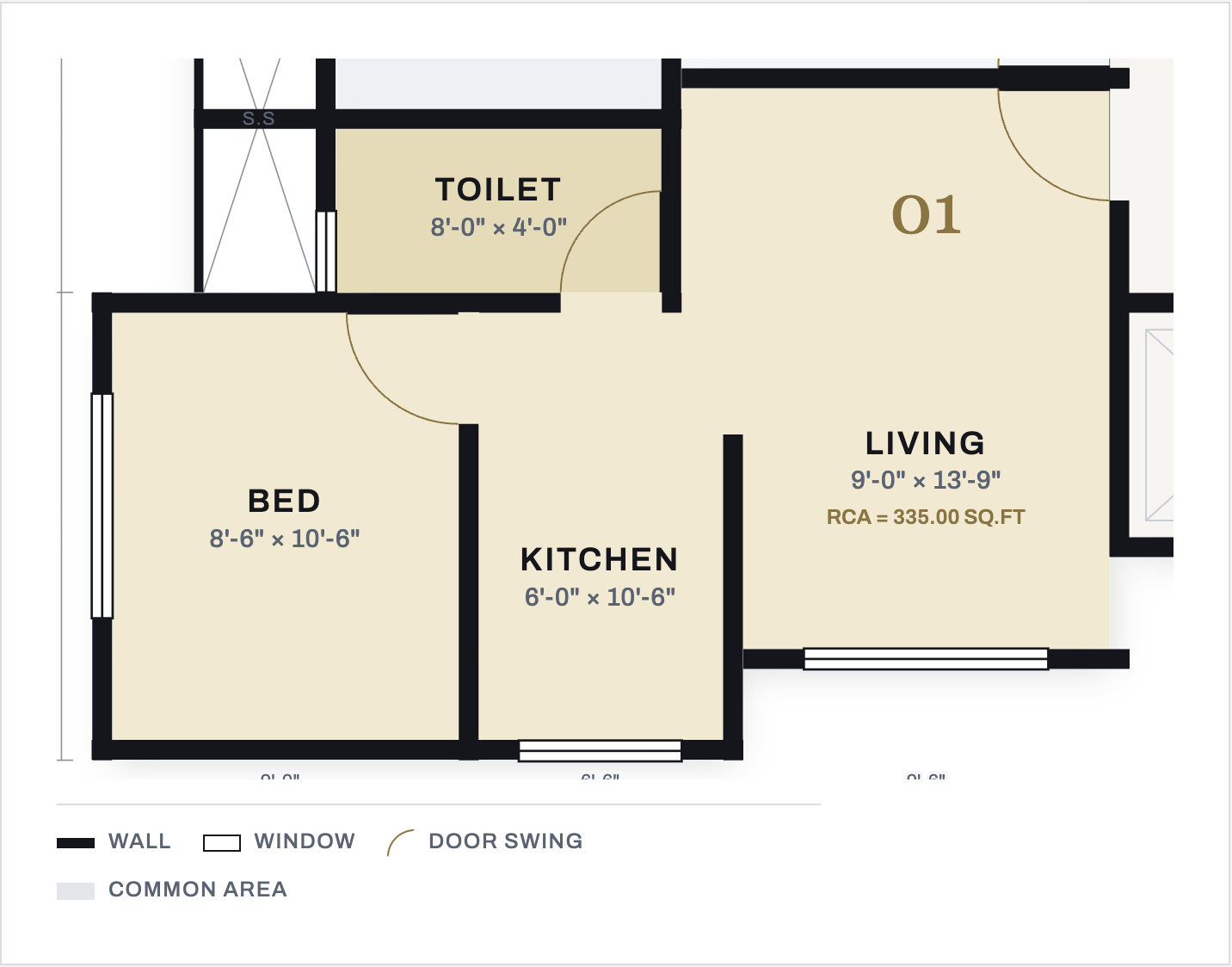

Redrawn from the architect's drawing dated 13/05/2025. Three homes to a floor, seven floors, three shops below. Areas are RERA carpet areas; dimensions as marked on the original, to be verified on site.

The drawings are ready.

Tap below and send us the message that opens in WhatsApp. The plans open here, and the price list comes back to you on WhatsApp.

Looking for
Get the plans on WhatsApp

Your own WhatsApp number, so we know it is real. No forms, no spam.

WallWindowDoor swingCommon area

Typical floor · 1st to 7th

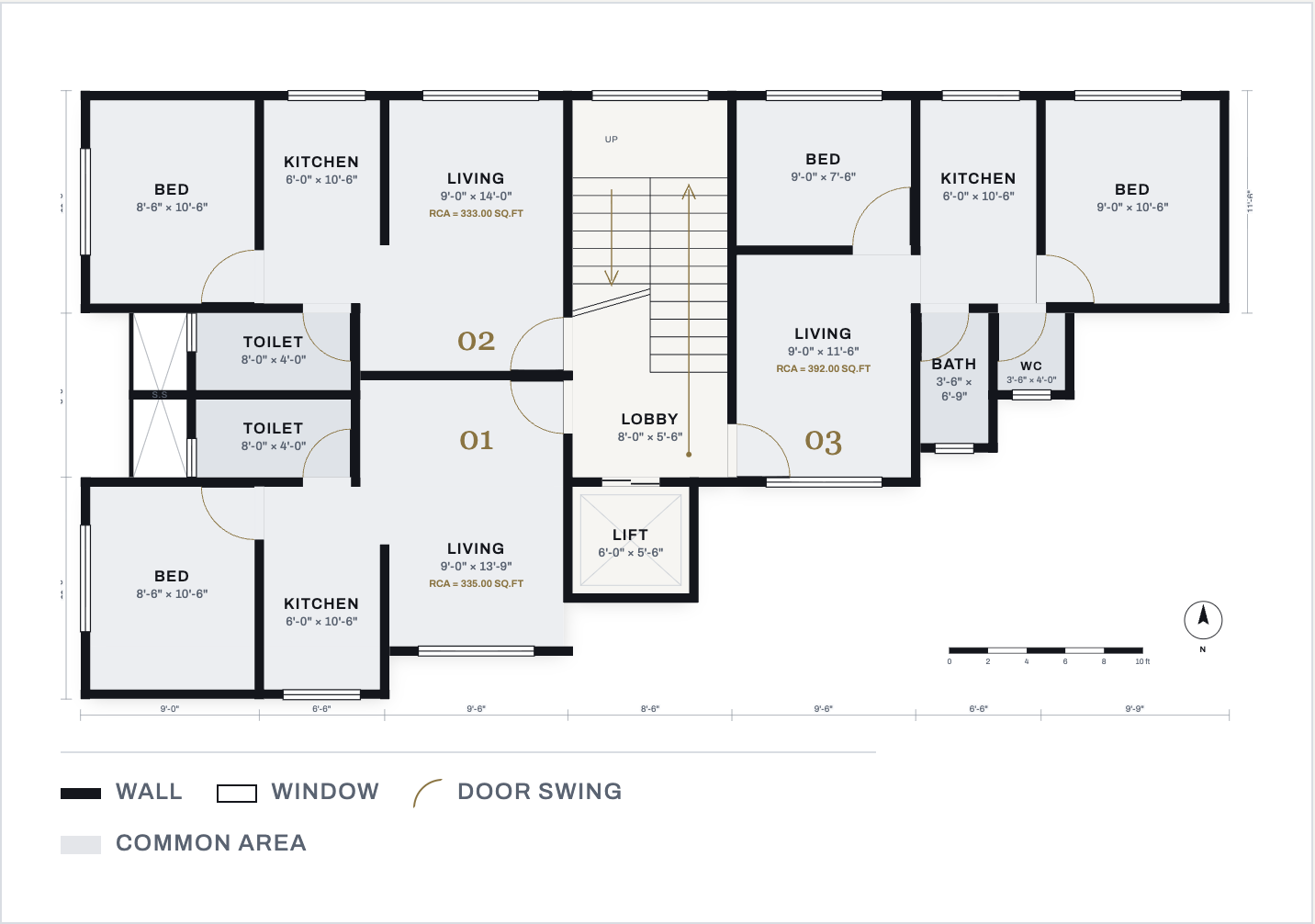

Three homes to a floor around a central lift and staircase lobby. The same plan repeats on every floor from the first to the seventh.

Homes per floor
3
Floors
1st – 7th
Homes in all
21
Lift
6'-0" × 5'-6"
Lobby
8'-0" × 5'-6"
Built-up per floor
≈ 1,400 sq ft

Want the price list and a site visit?

Ask on WhatsApp

Sheet 03Floor plansFrom the architect's drawing, 13/05/2025Verify on site

On site, month by month

Real photographs from the site, dated by the camera that took them. No renders here. Latest photographs 21 July 2026; latest videos 5 September 2026.

  1. Excavation & foundationComplete · Dec 2025
  2. PlinthComplete · Feb 2026
  3. StructureIn progress · two slabs cast by July 2026
  4. Masonry & services
  5. Finishes
  6. Handovertbc

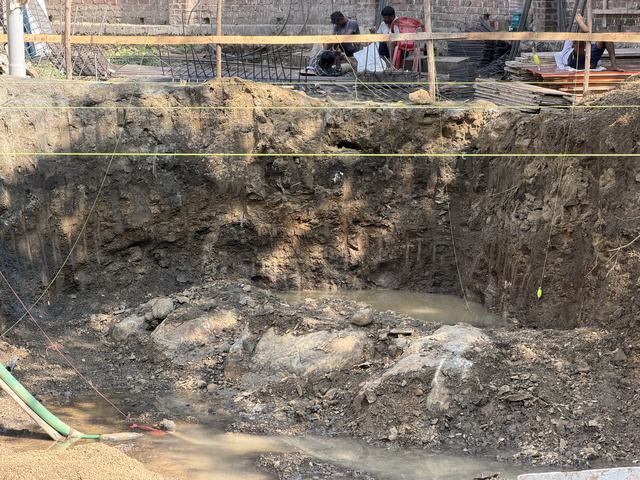

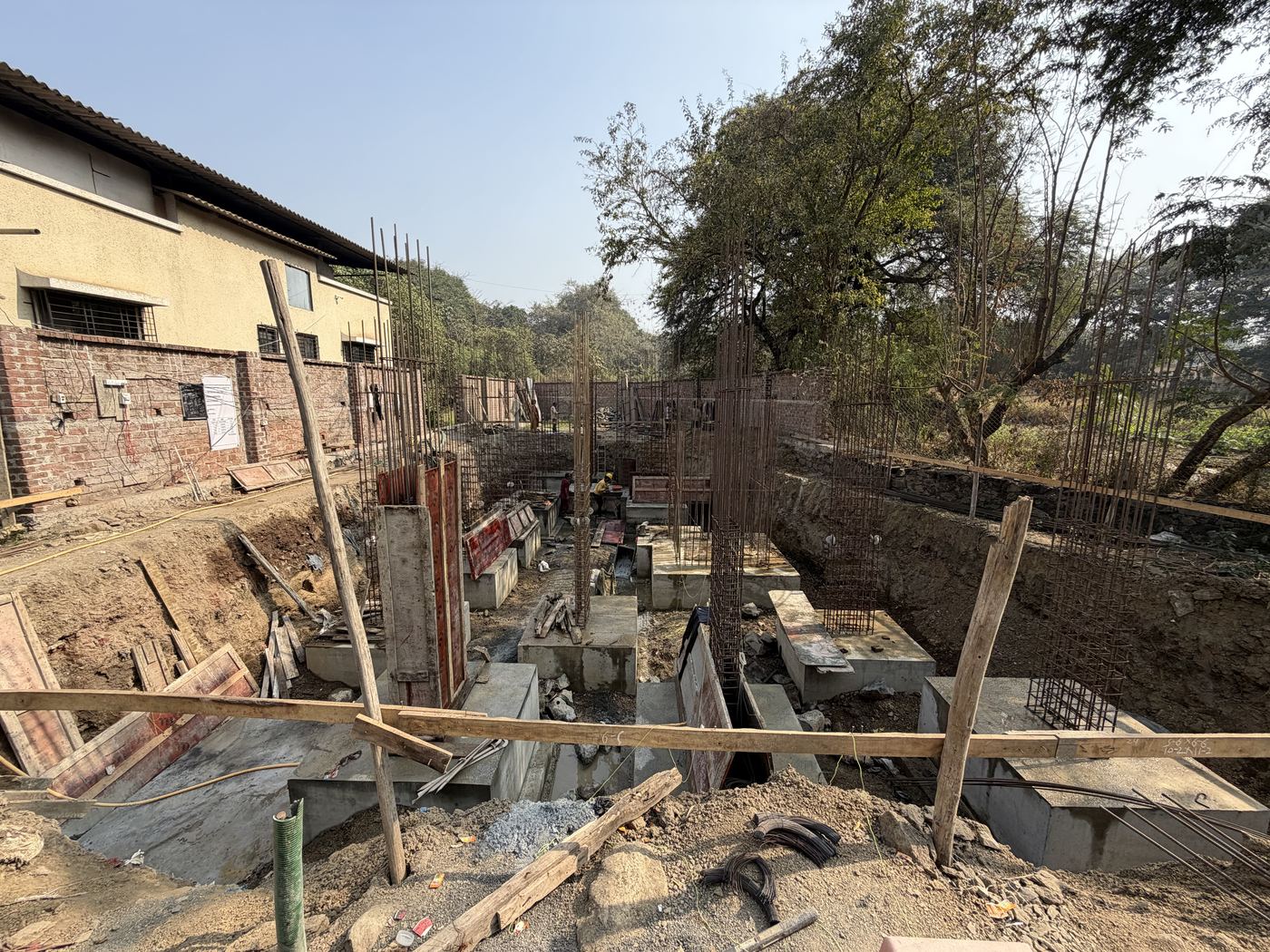

  1. 18Dec 2025

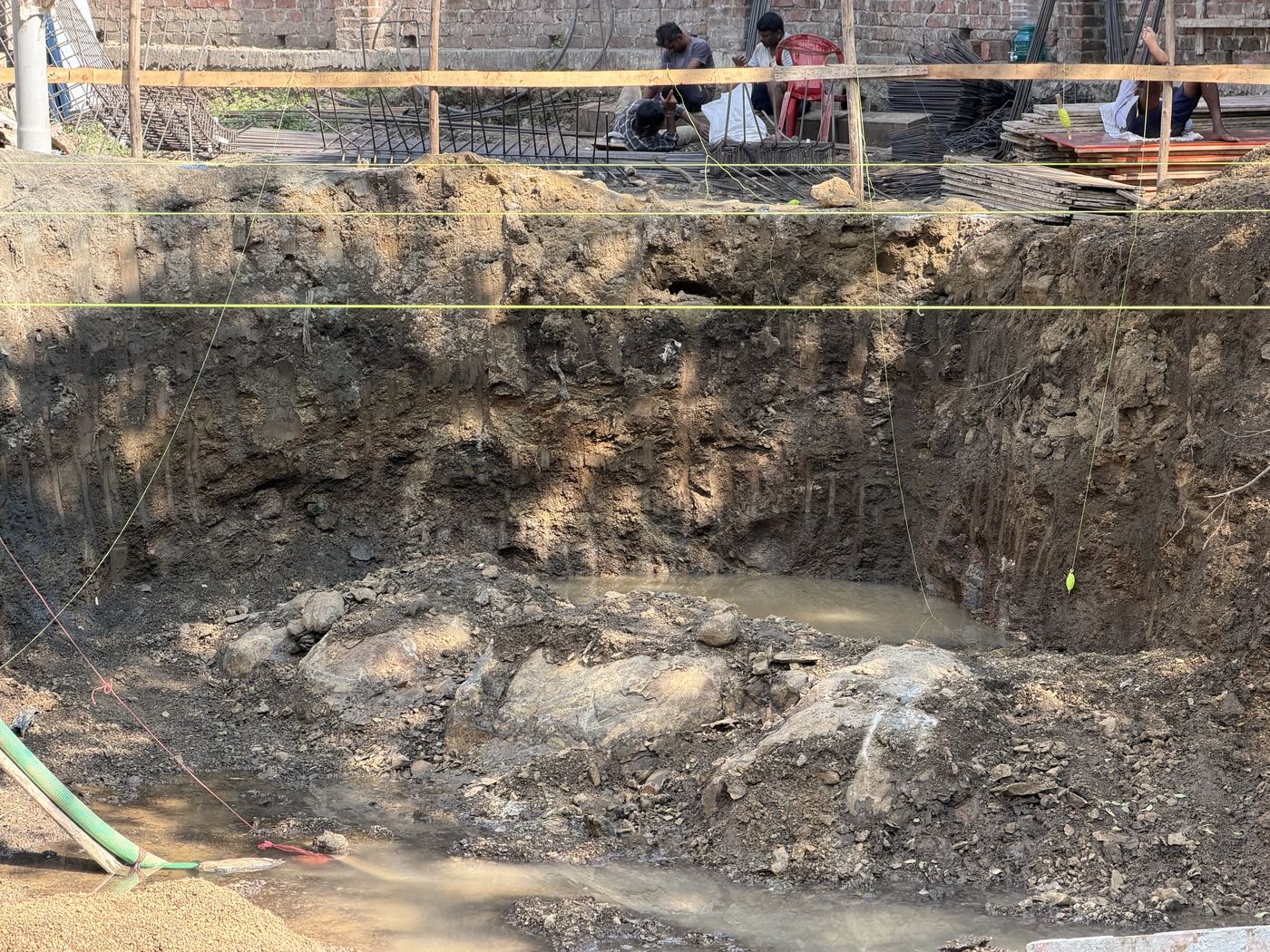

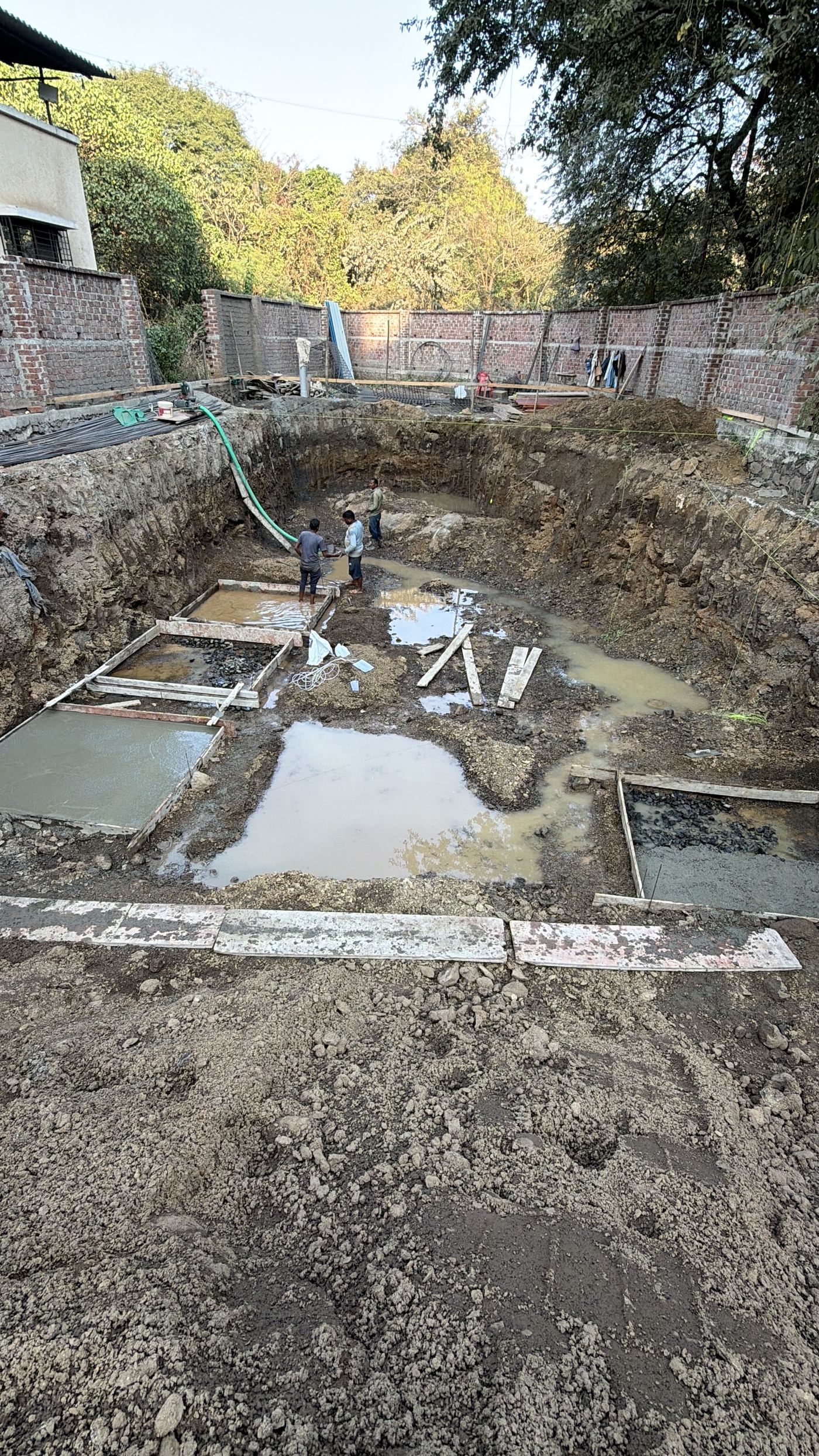

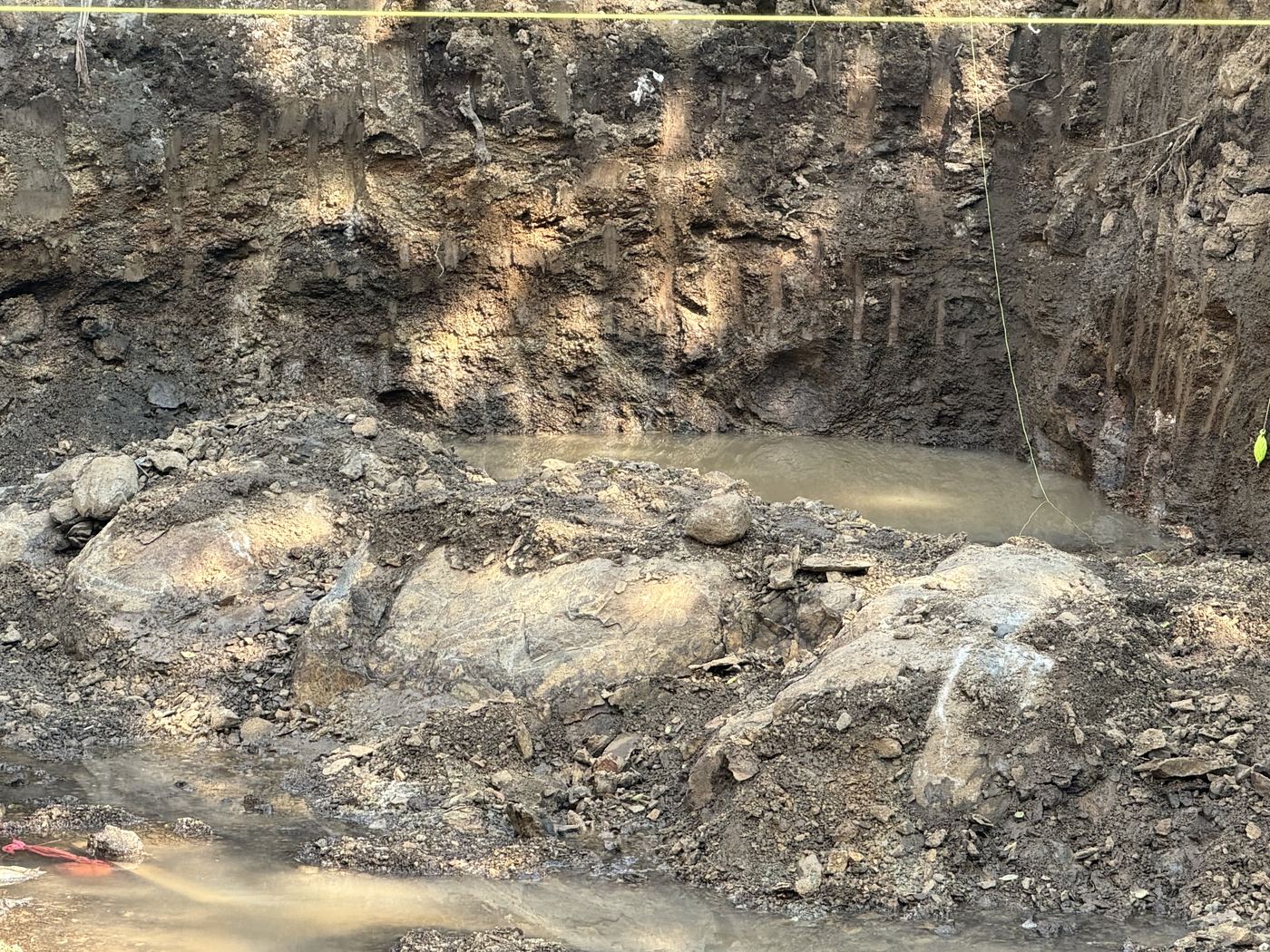

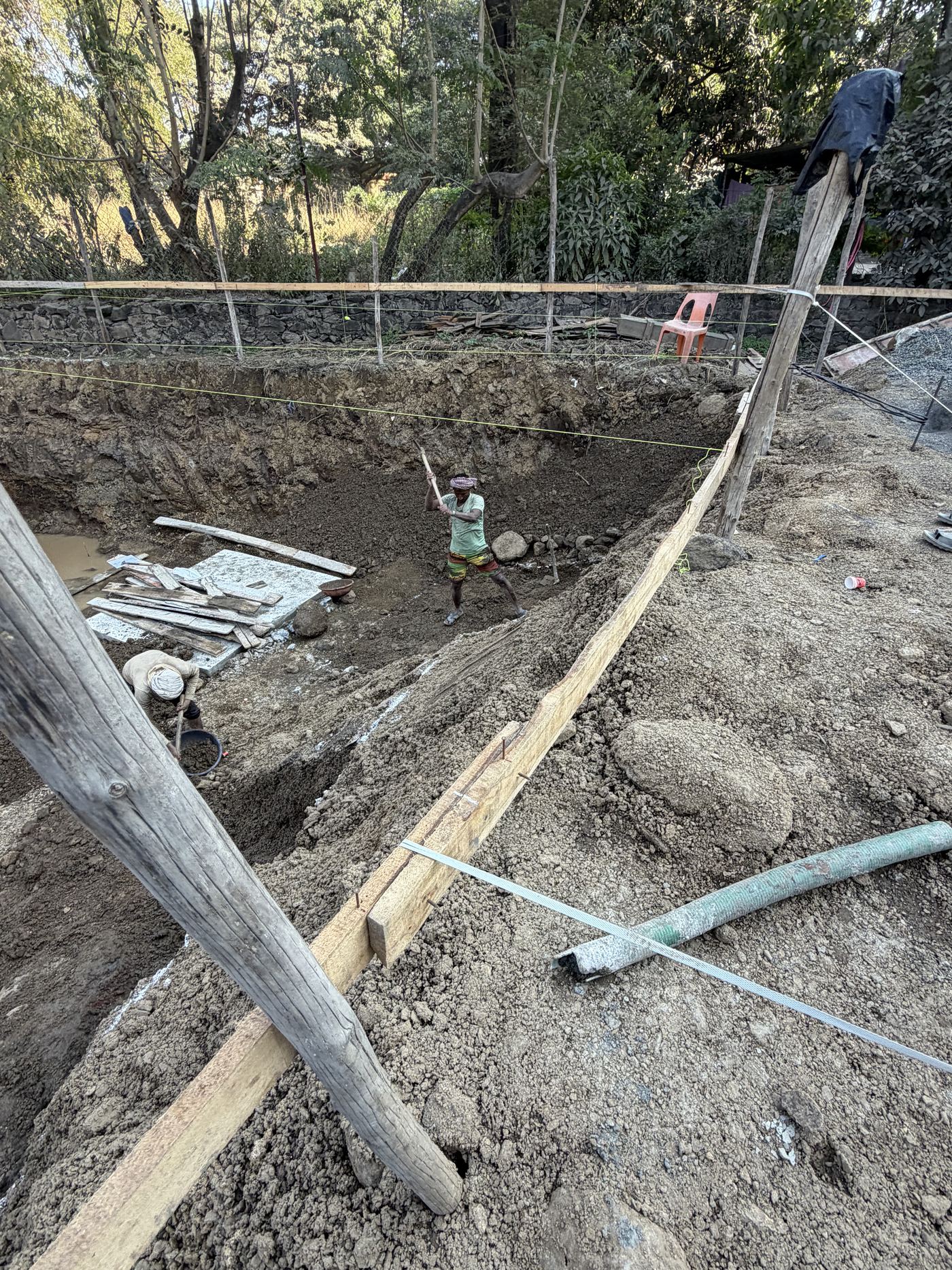

    Excavation

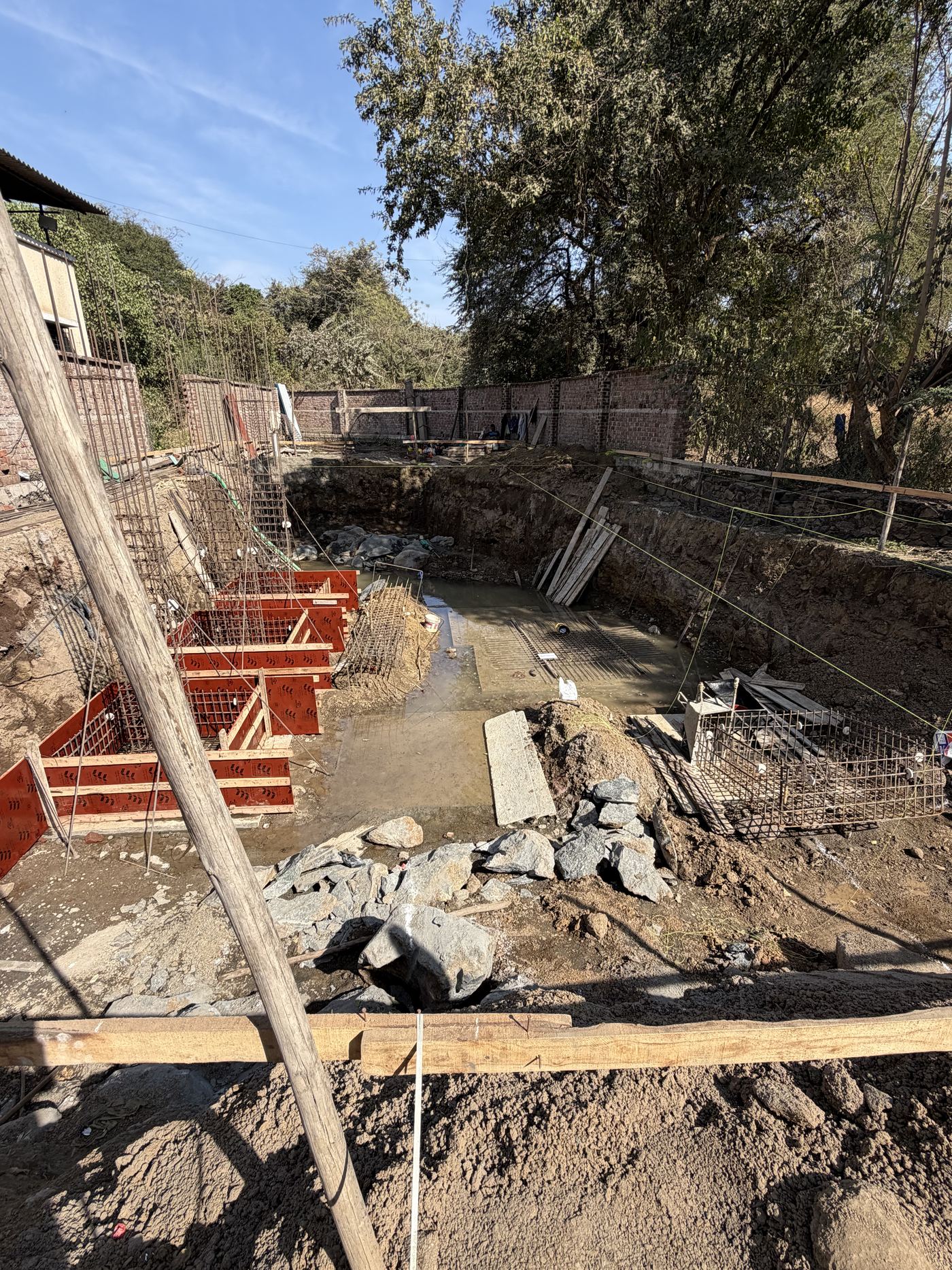

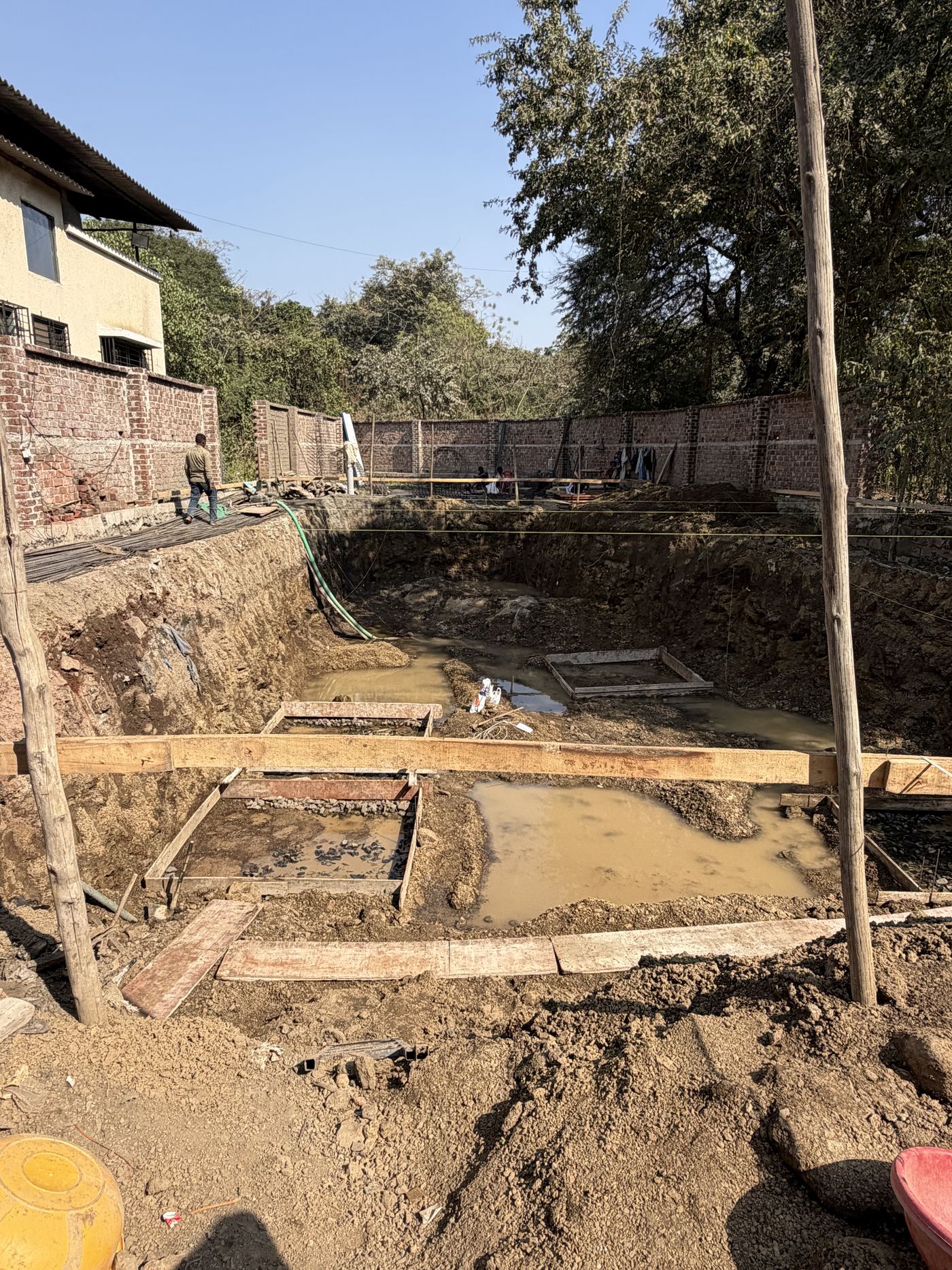

    The pit dug down to rock and pumped dry, string lines set out for the footings.

    Site photograph, 2025-12-18Site photograph, 2025-12-18Site photograph, 2025-12-18Site photograph, 2025-12-18
  2. 19Dec 2025

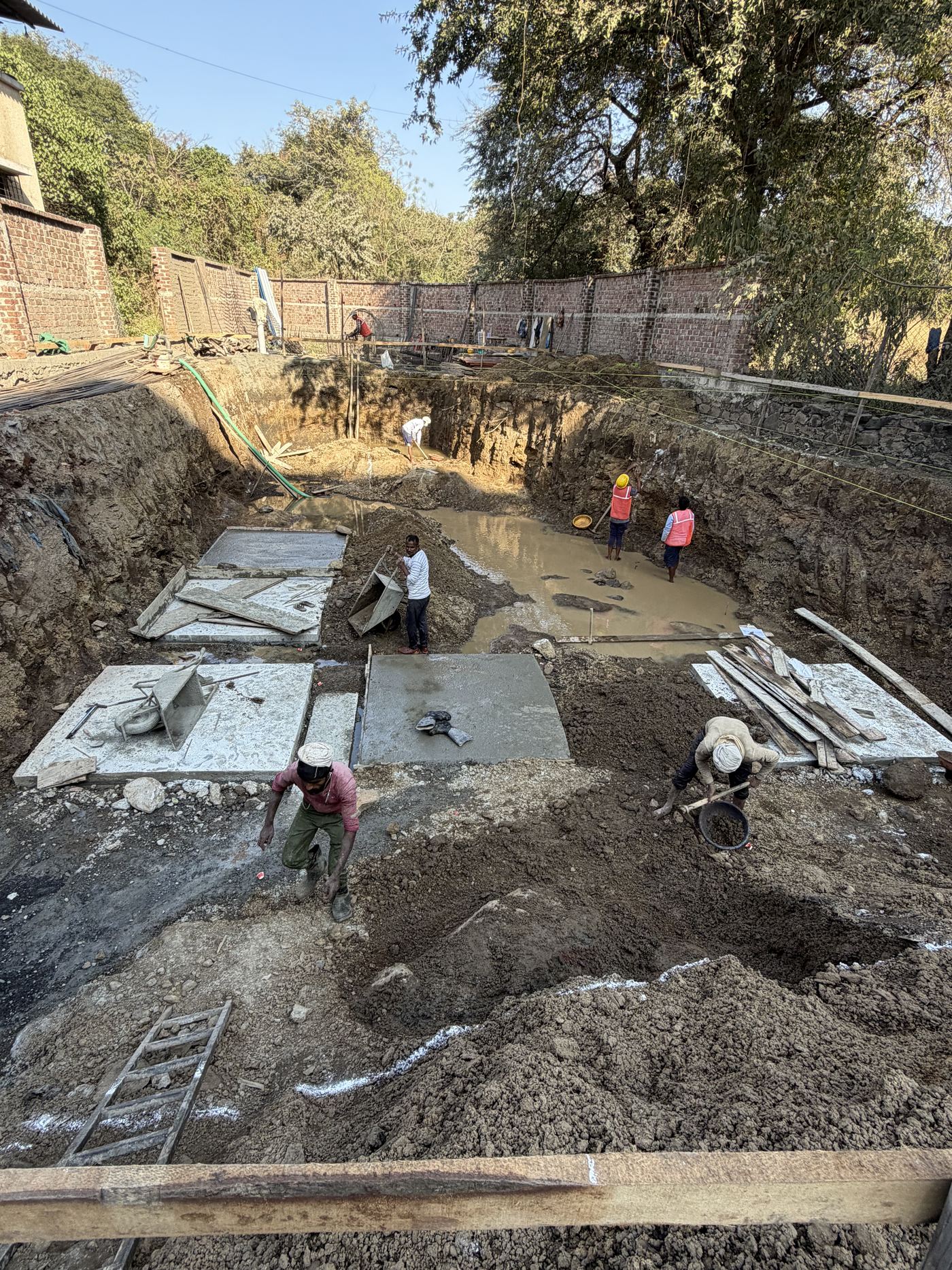

    Footings

    Levelling concrete laid in the pit and the first footings marked out and cast.

    Site photograph, 2025-12-19Site photograph, 2025-12-19
  3. 23–24Dec 2025

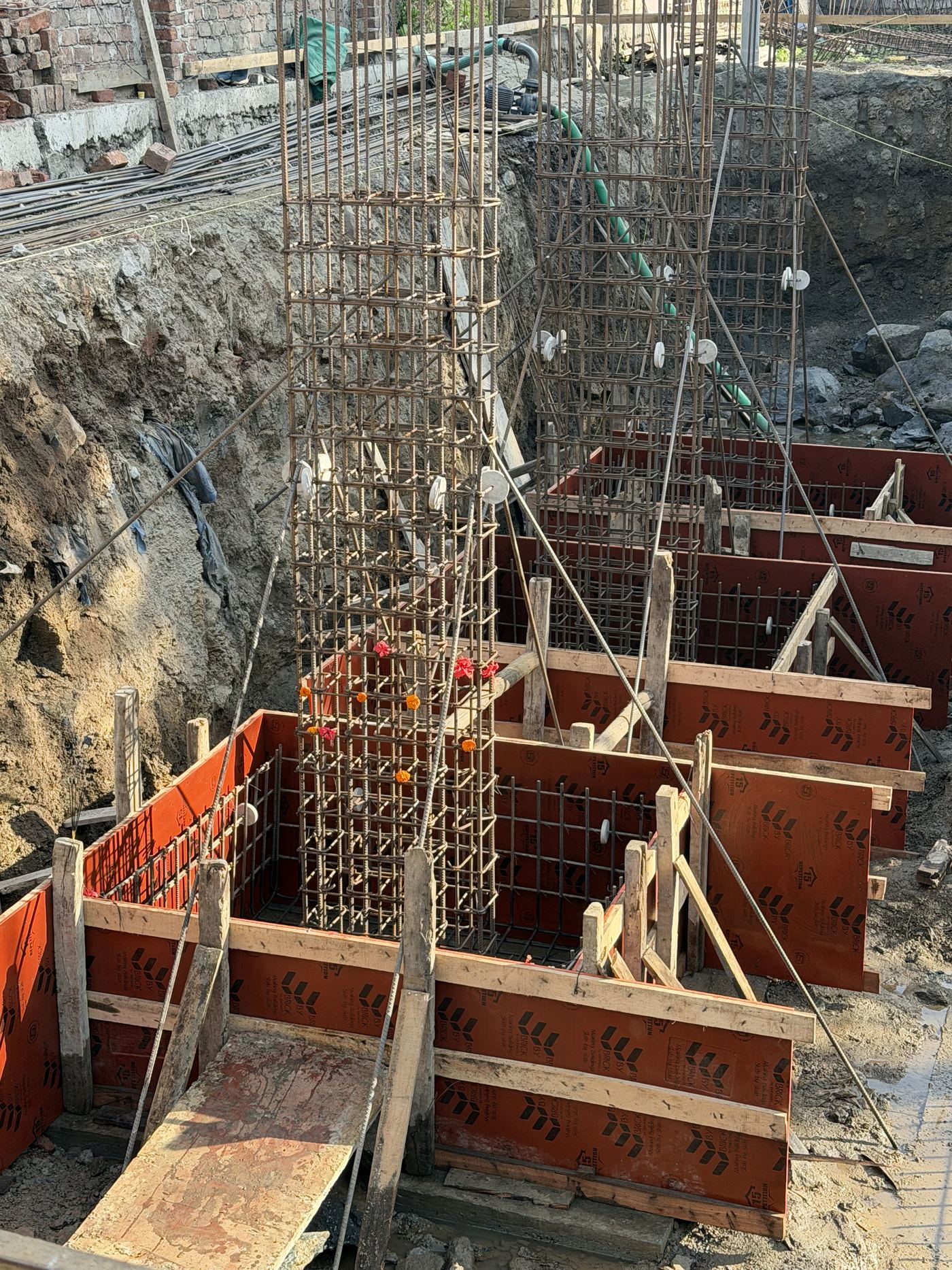

    Column cages

    Reinforcement for the foundation columns tied, boxed in formwork and ready for concrete.

    Site photograph, 2025-12-24Site photograph, 2025-12-23
  4. 17Jan 2026

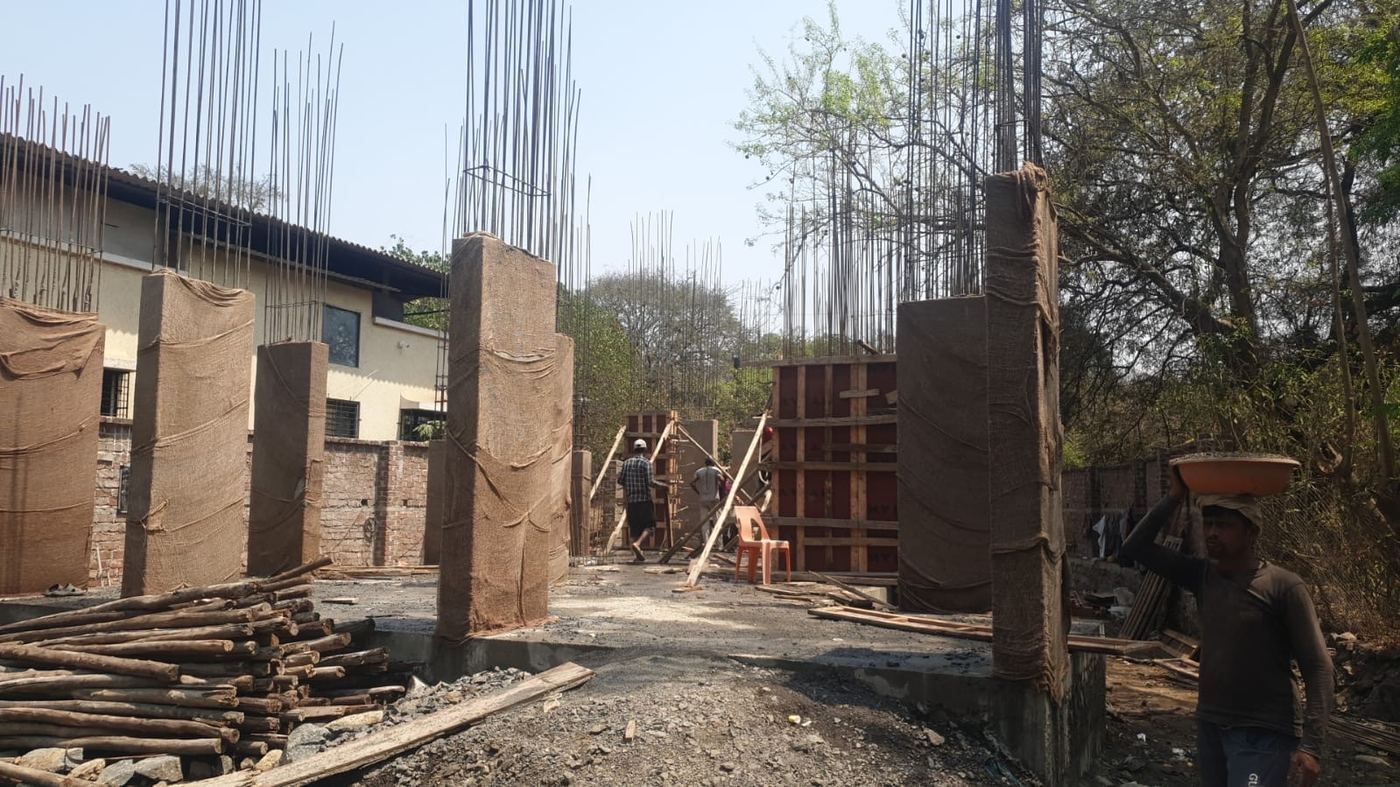

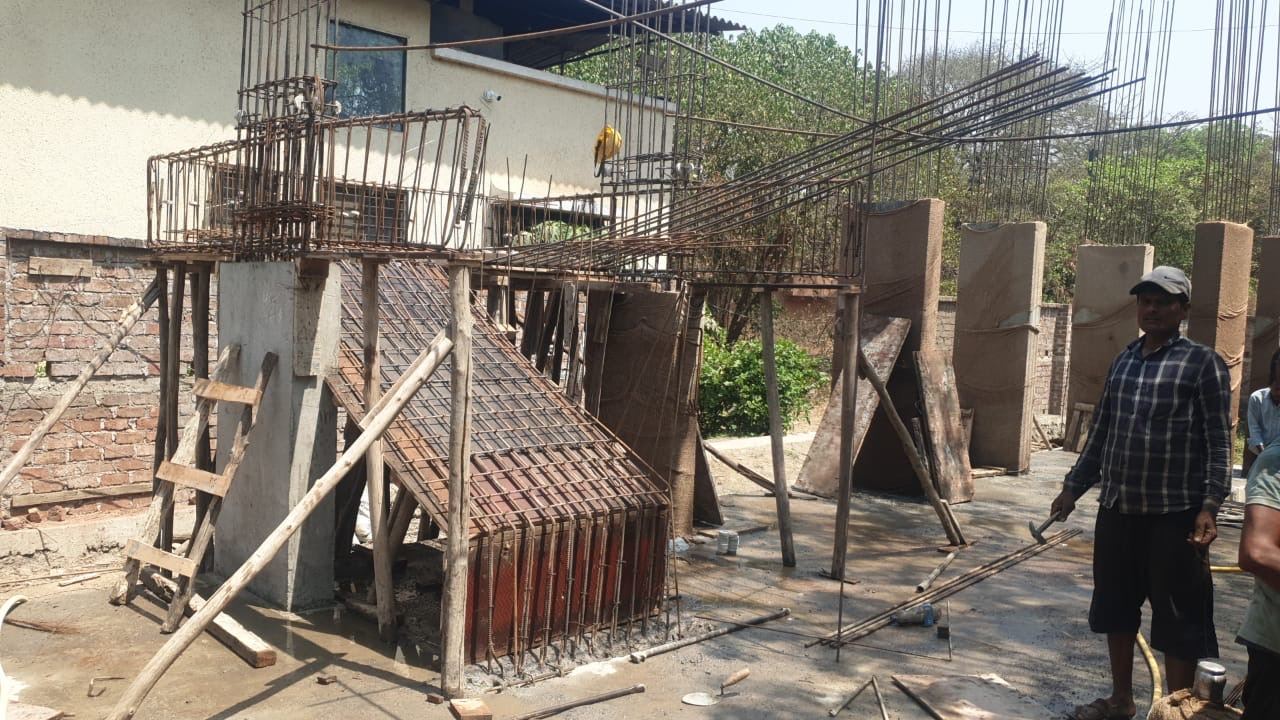

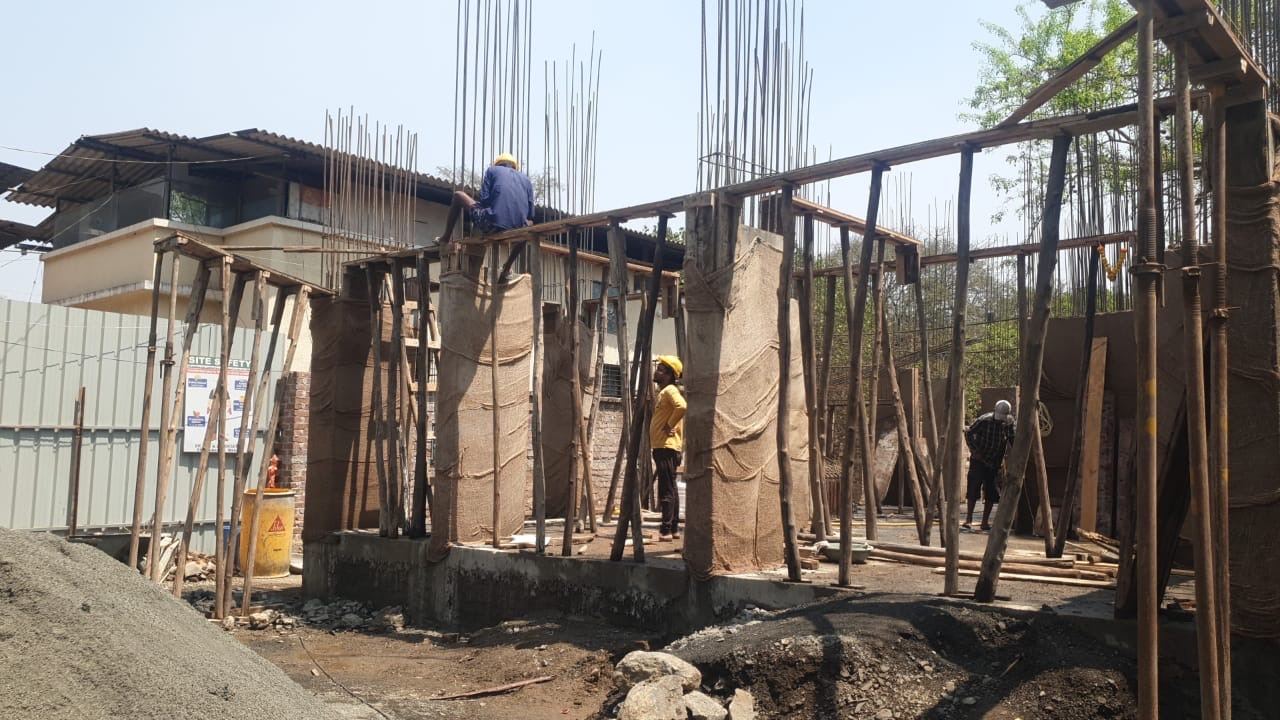

    Foundation columns

    Foundation columns cast; the plinth beams being shuttered along the road side.

    Site photograph, 2026-01-17
  5. 24–25Feb 2026

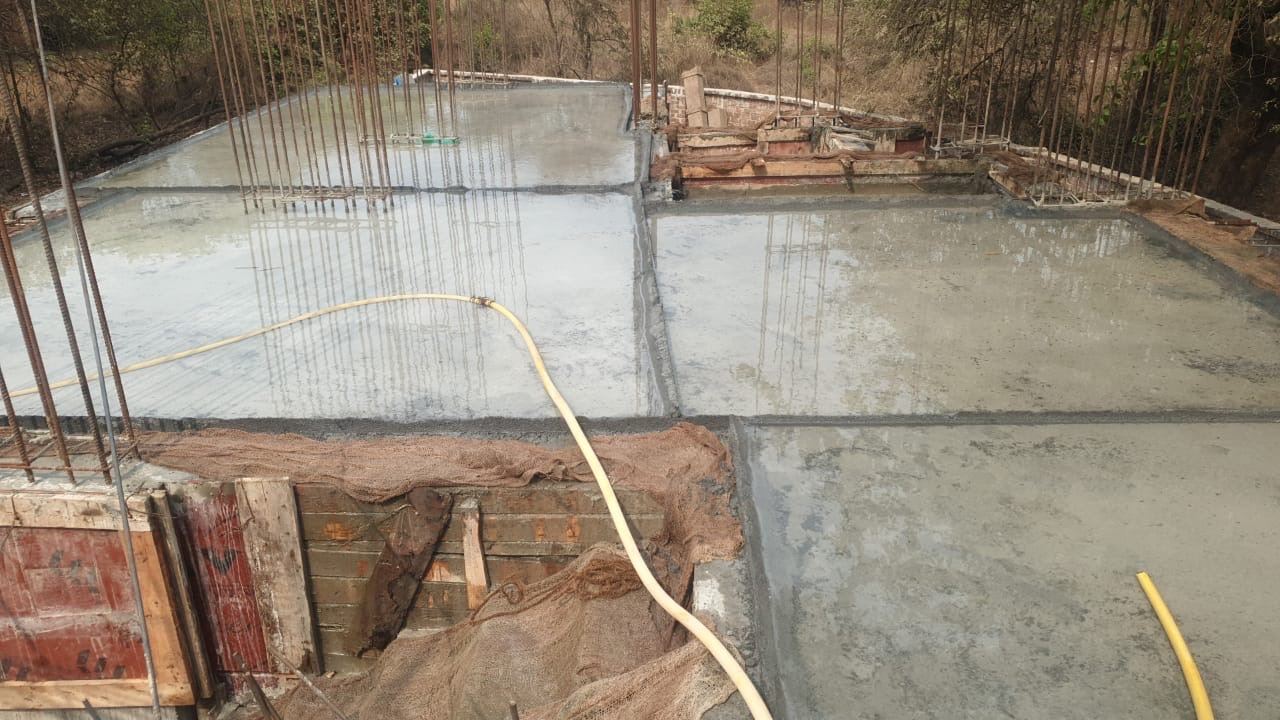

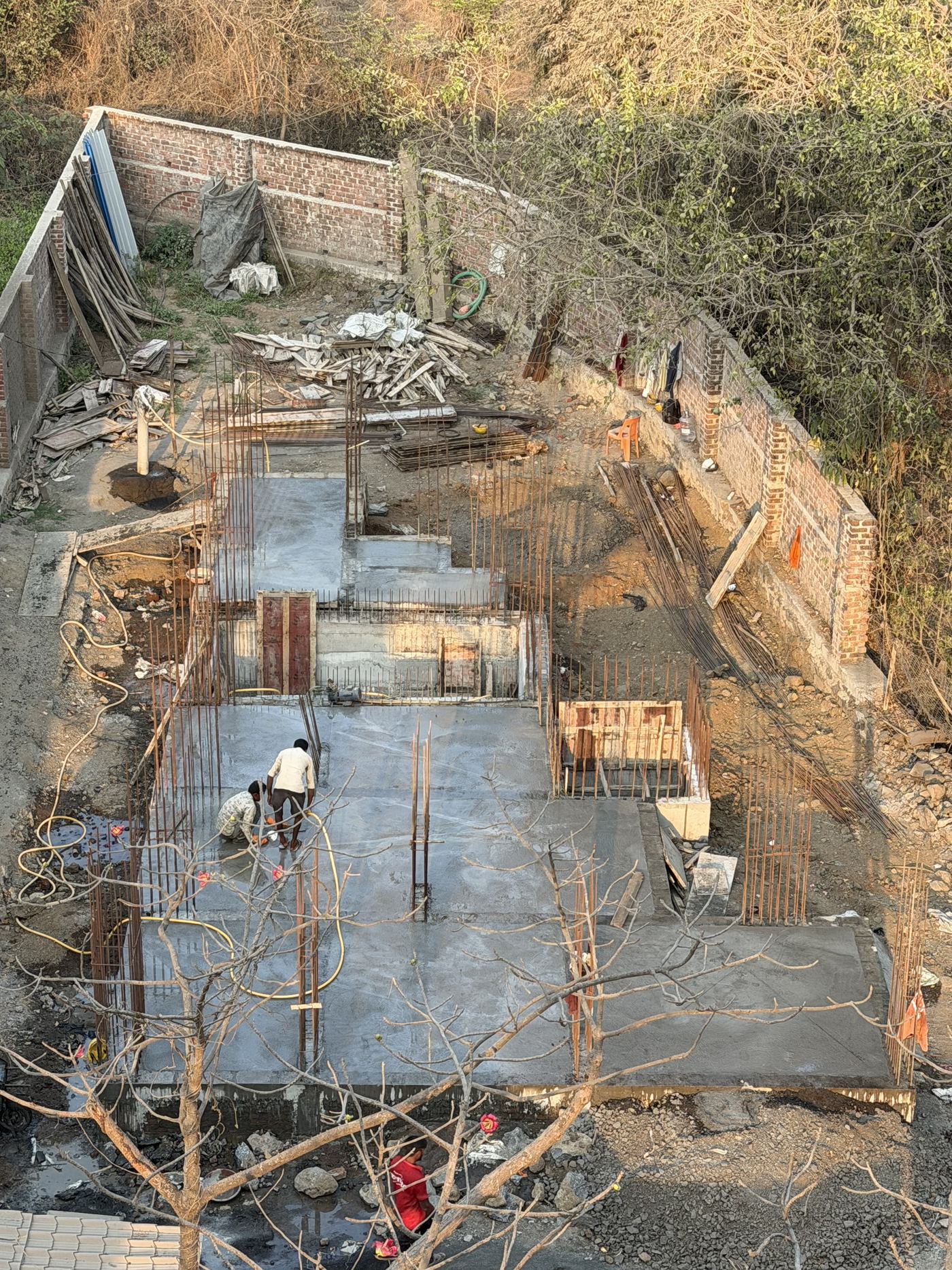

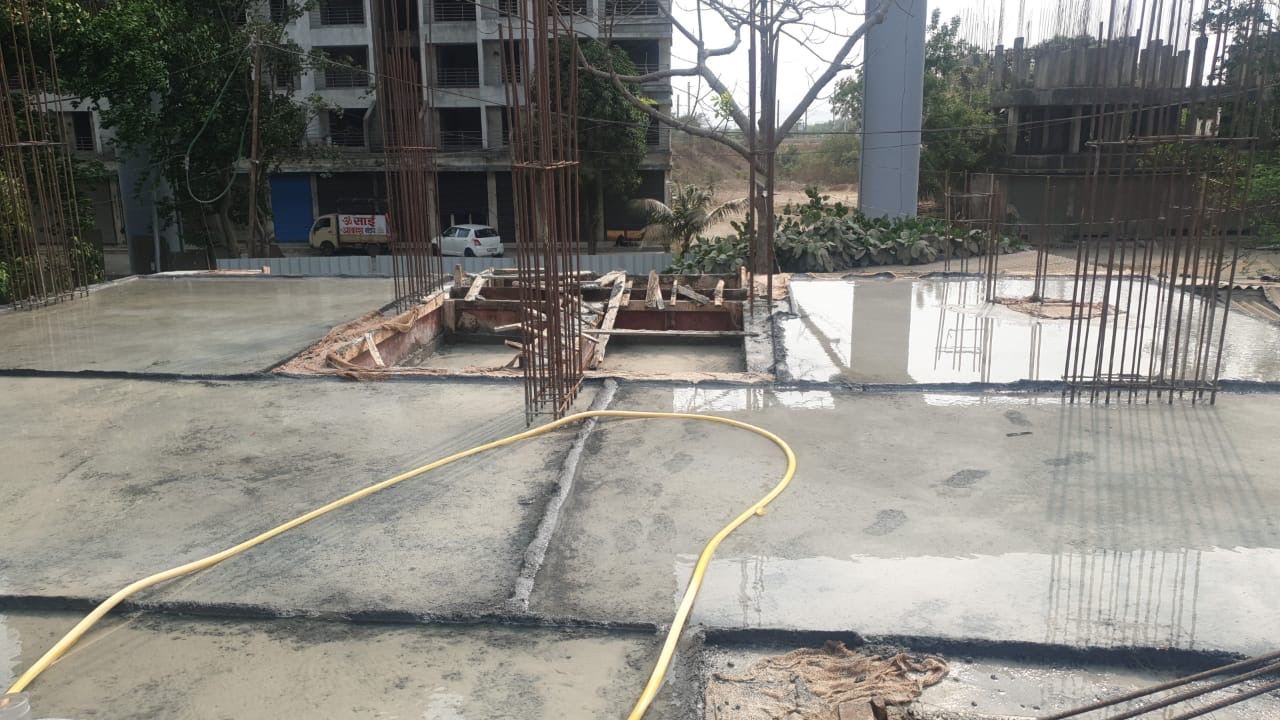

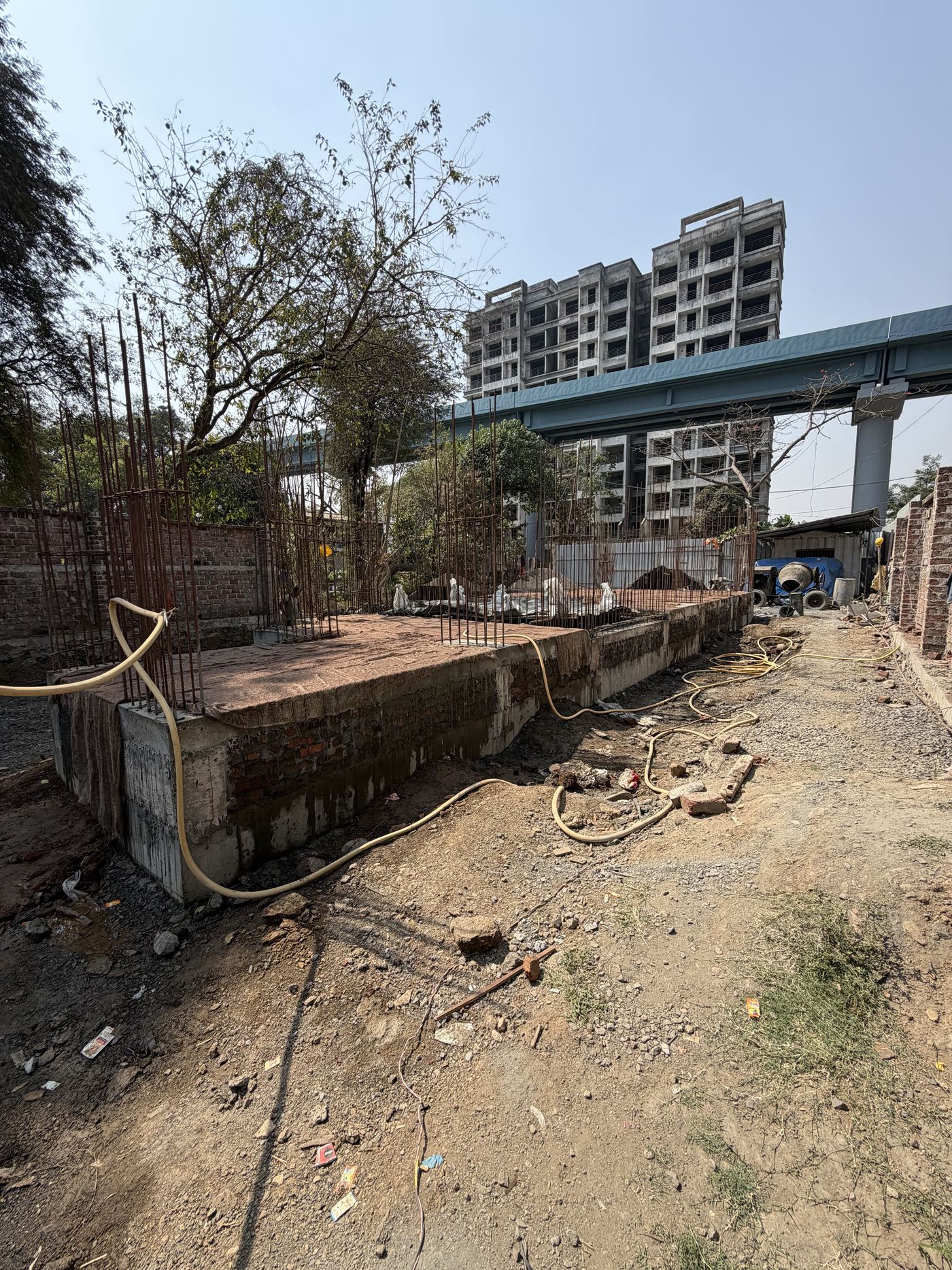

    Plinth complete

    Plinth beams and slab cast, the plinth wall up, and the column starter bars ready for the ground floor.

    Site photograph, 2026-02-24Site photograph, 2026-02-25Site photograph, 2026-02-25Site photograph, 2026-02-24Site photograph, 2026-02-25Site photograph, 2026-02-25Site photograph, 2026-02-25Site photograph, 2026-02-25
  6. 24–31Mar 2026

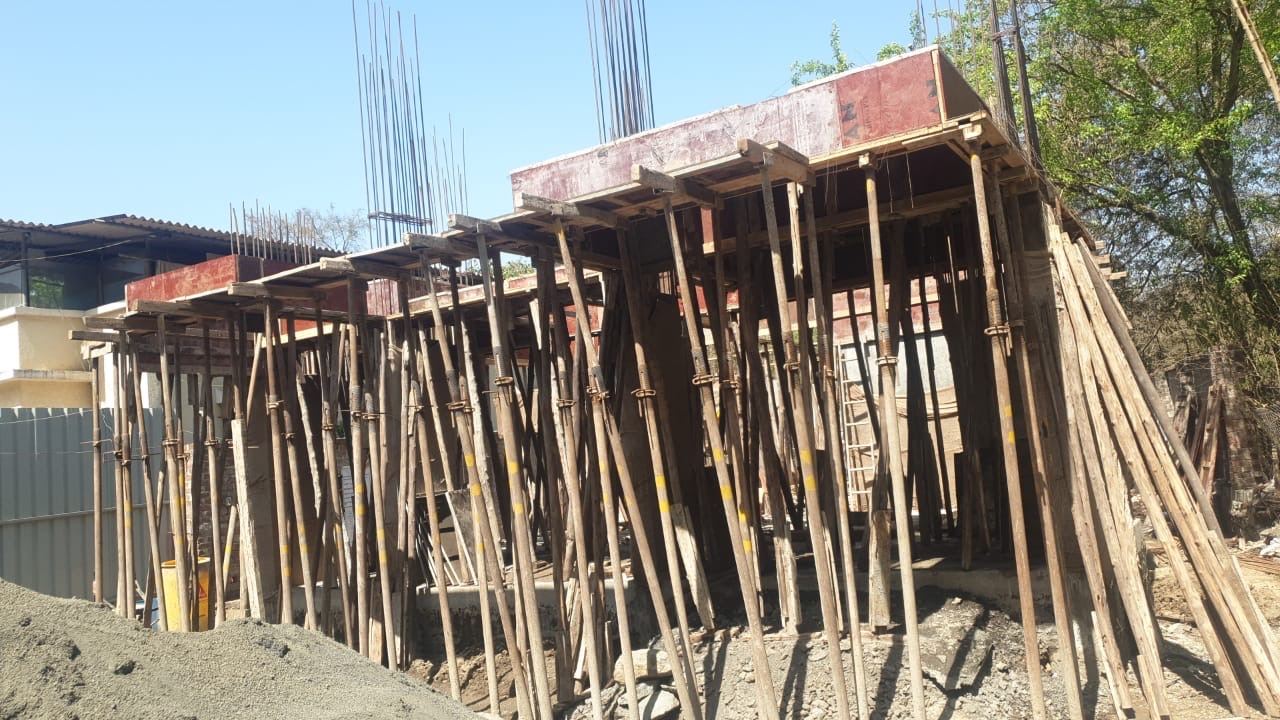

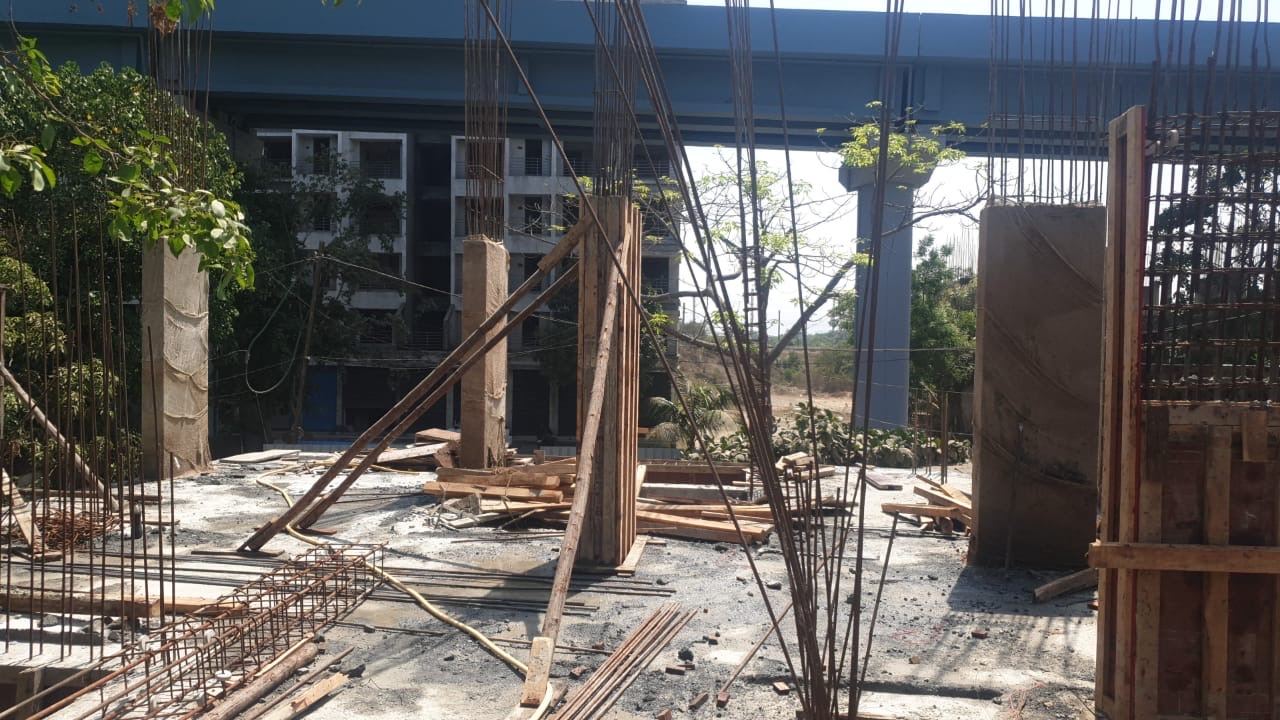

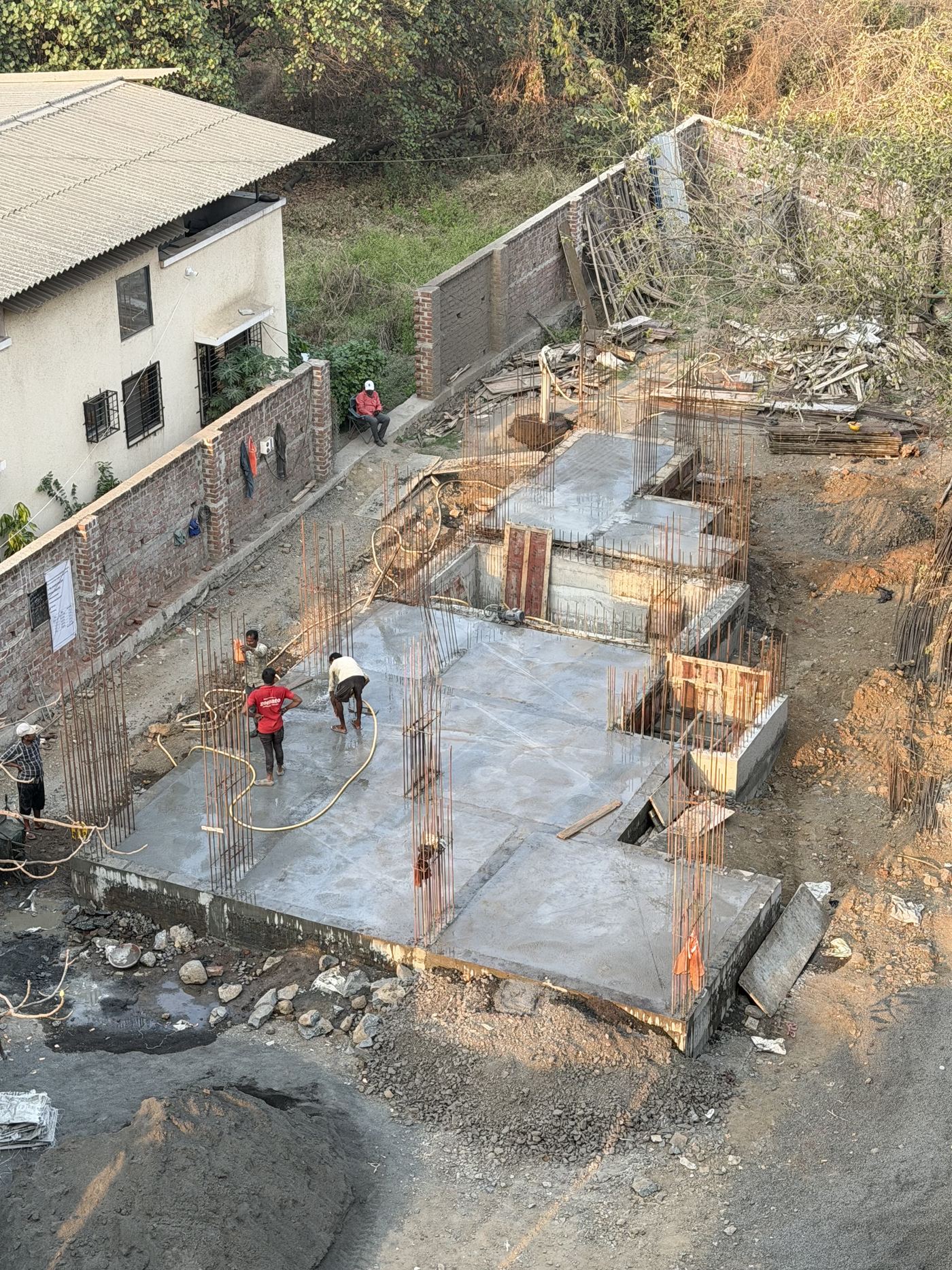

    Ground floor columns

    Ground floor columns cast and curing under hessian; the staircase and lift core taking shape.

    Site photograph, 2026-03-24Site photograph, 2026-03-28Site photograph, 2026-03-28Site photograph, 2026-03-31
  7. 5–9Apr 2026

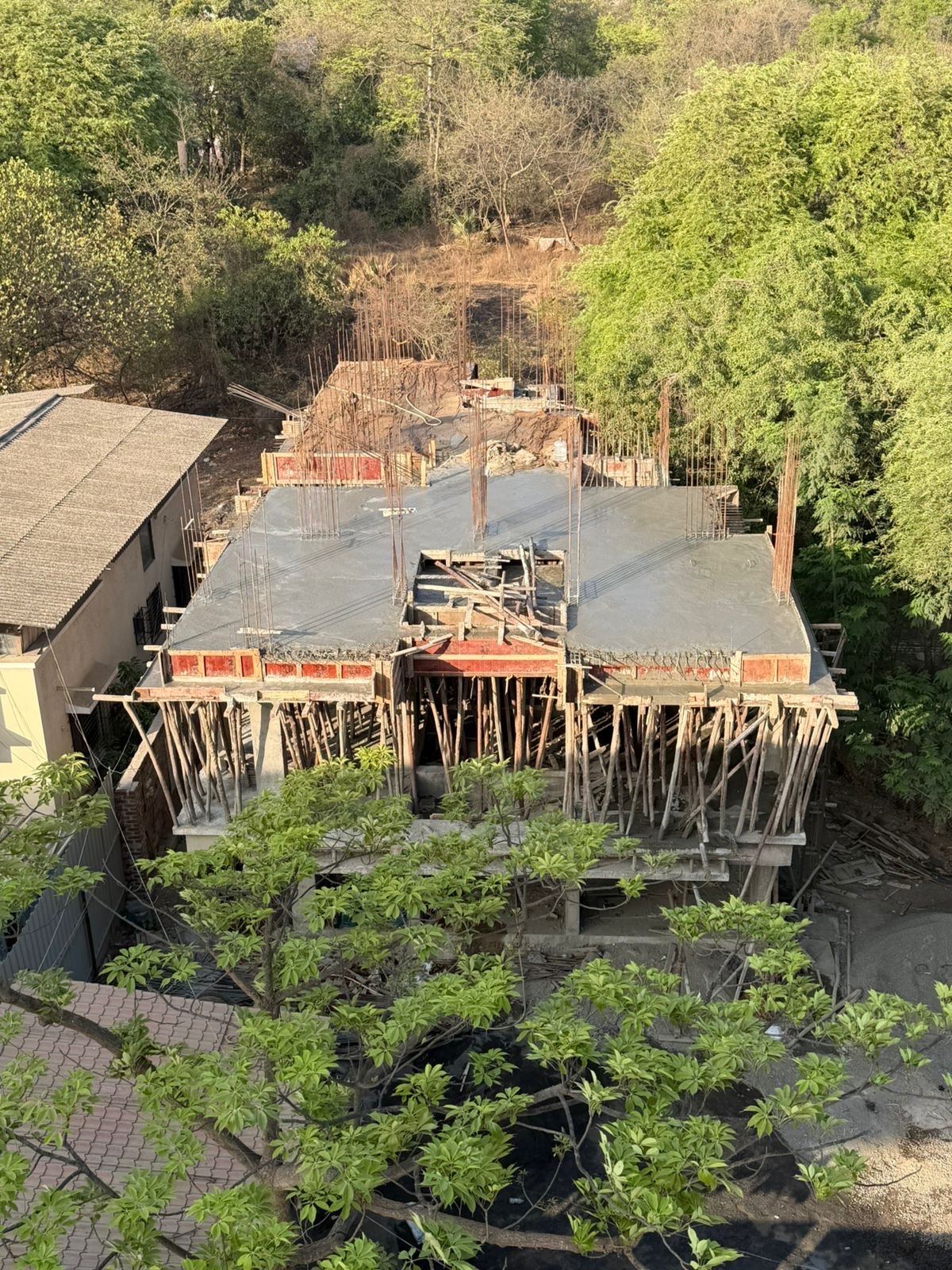

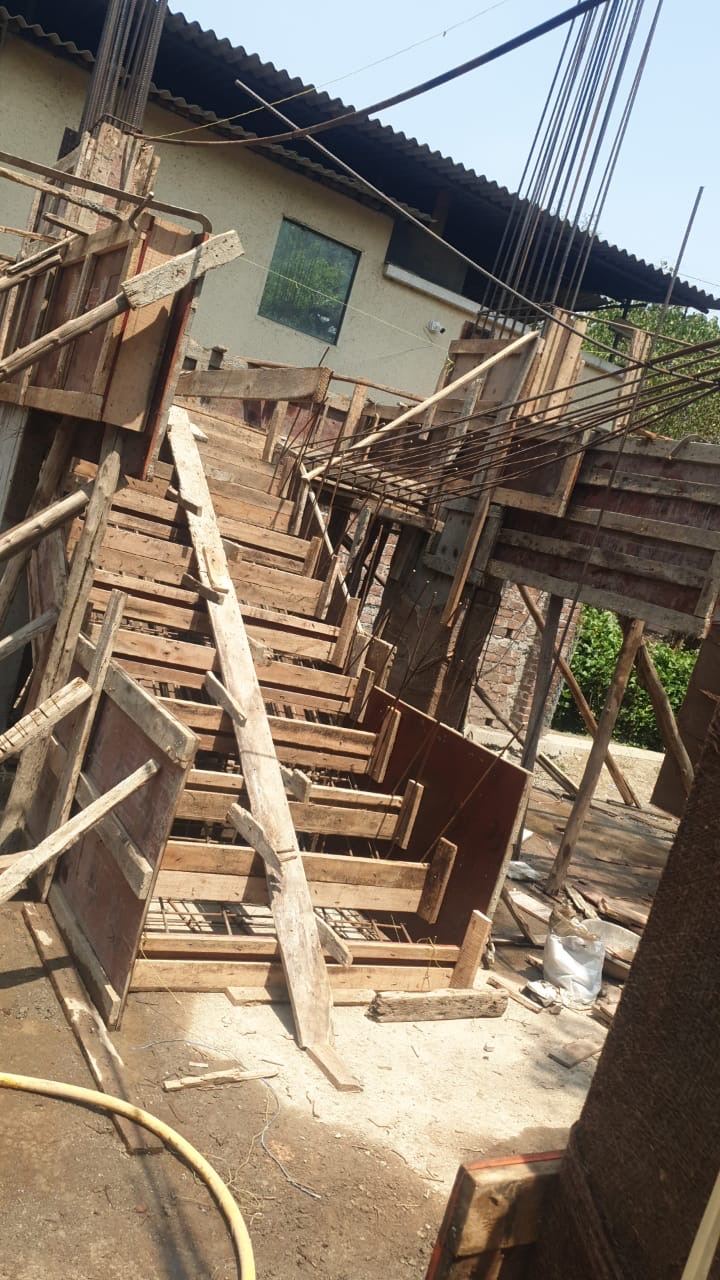

    Shuttering the first slab

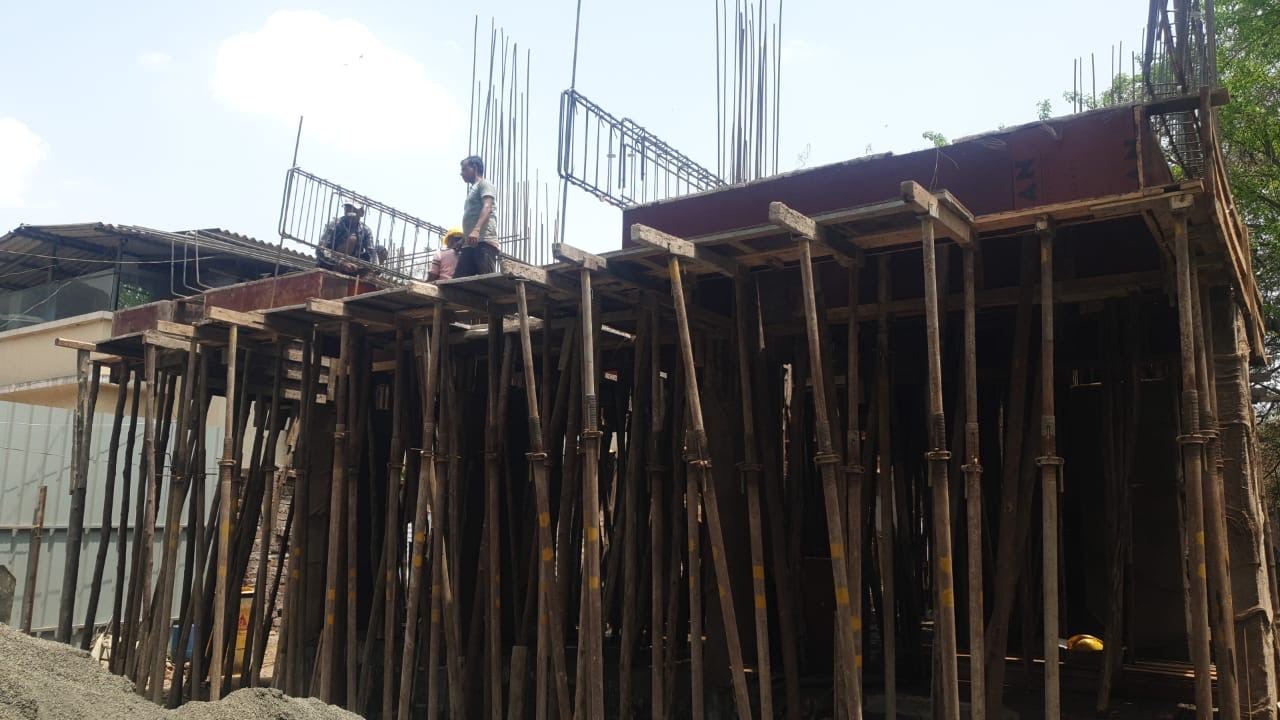

    Props and formwork over the whole ground floor, ready for the first slab.

    Site photograph, 2026-04-09Site photograph, 2026-04-05
  8. 16–19Apr 2026

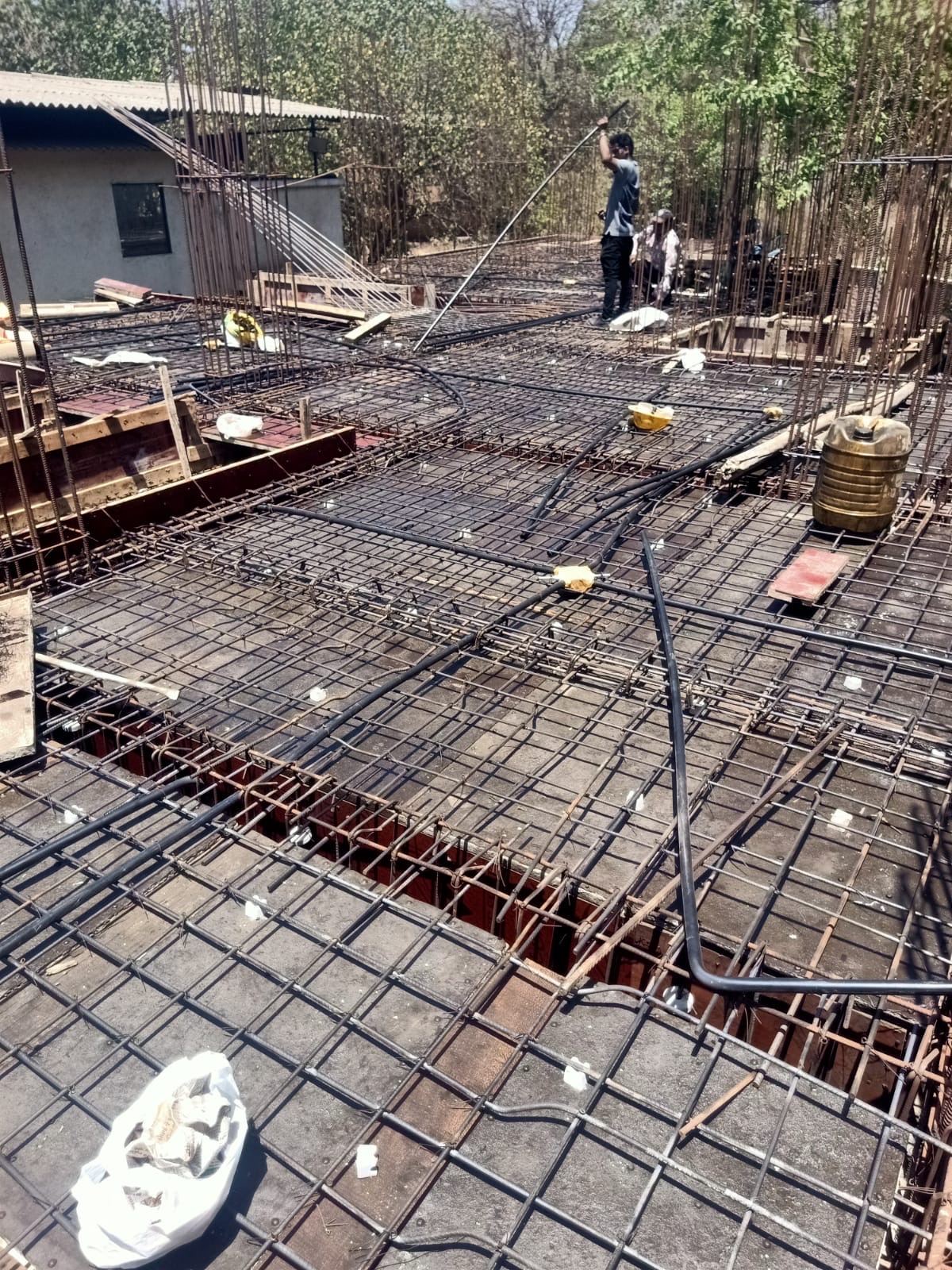

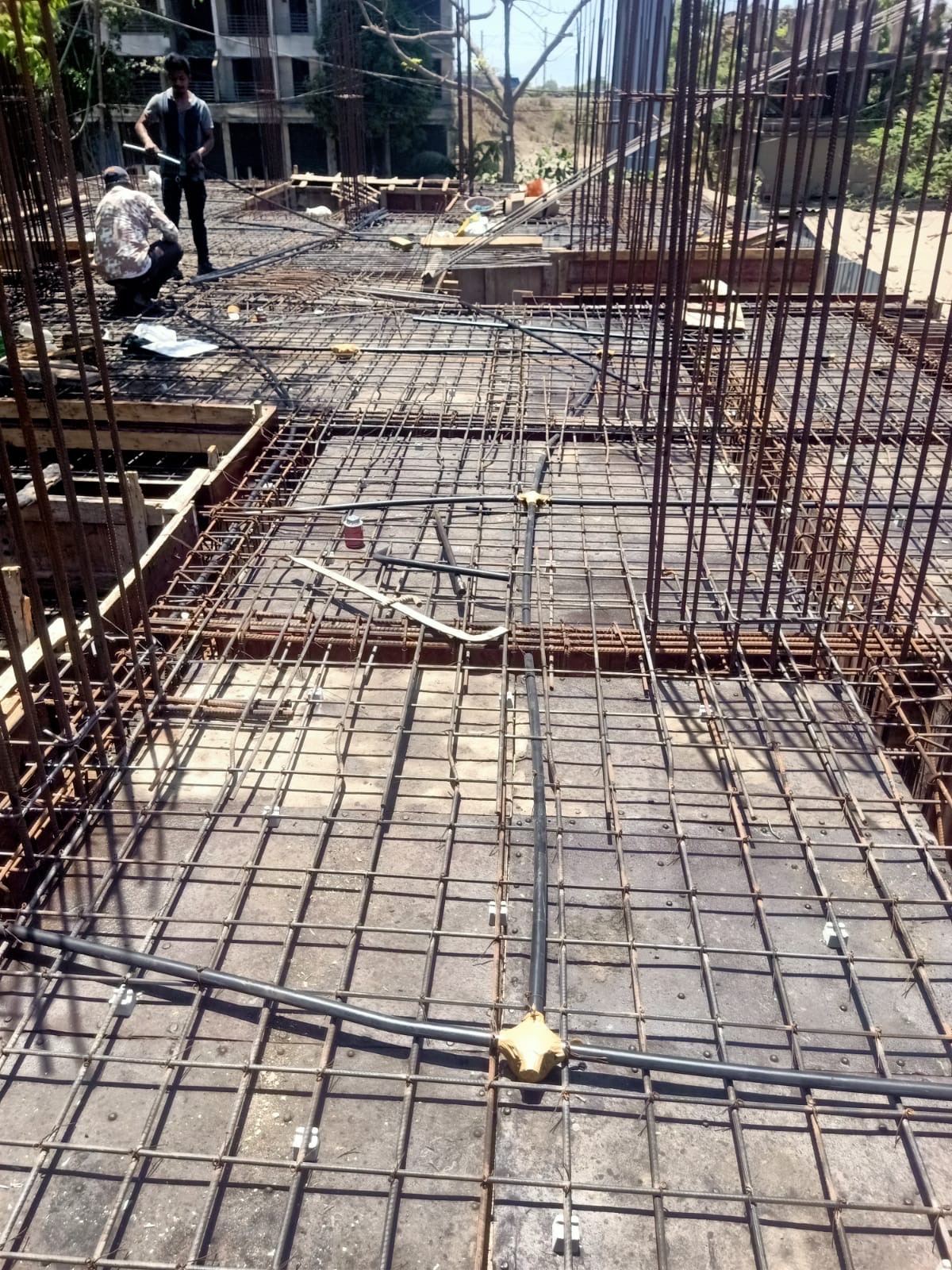

    First slab cast

    Reinforcement and conduits laid on the 16th, concrete poured on the 17th, the slab curing by the 19th.

    Site photograph, 2026-04-17Site photograph, 2026-04-16Site photograph, 2026-04-16Site photograph, 2026-04-19Site photograph, 2026-04-19
  9. 3–6May 2026

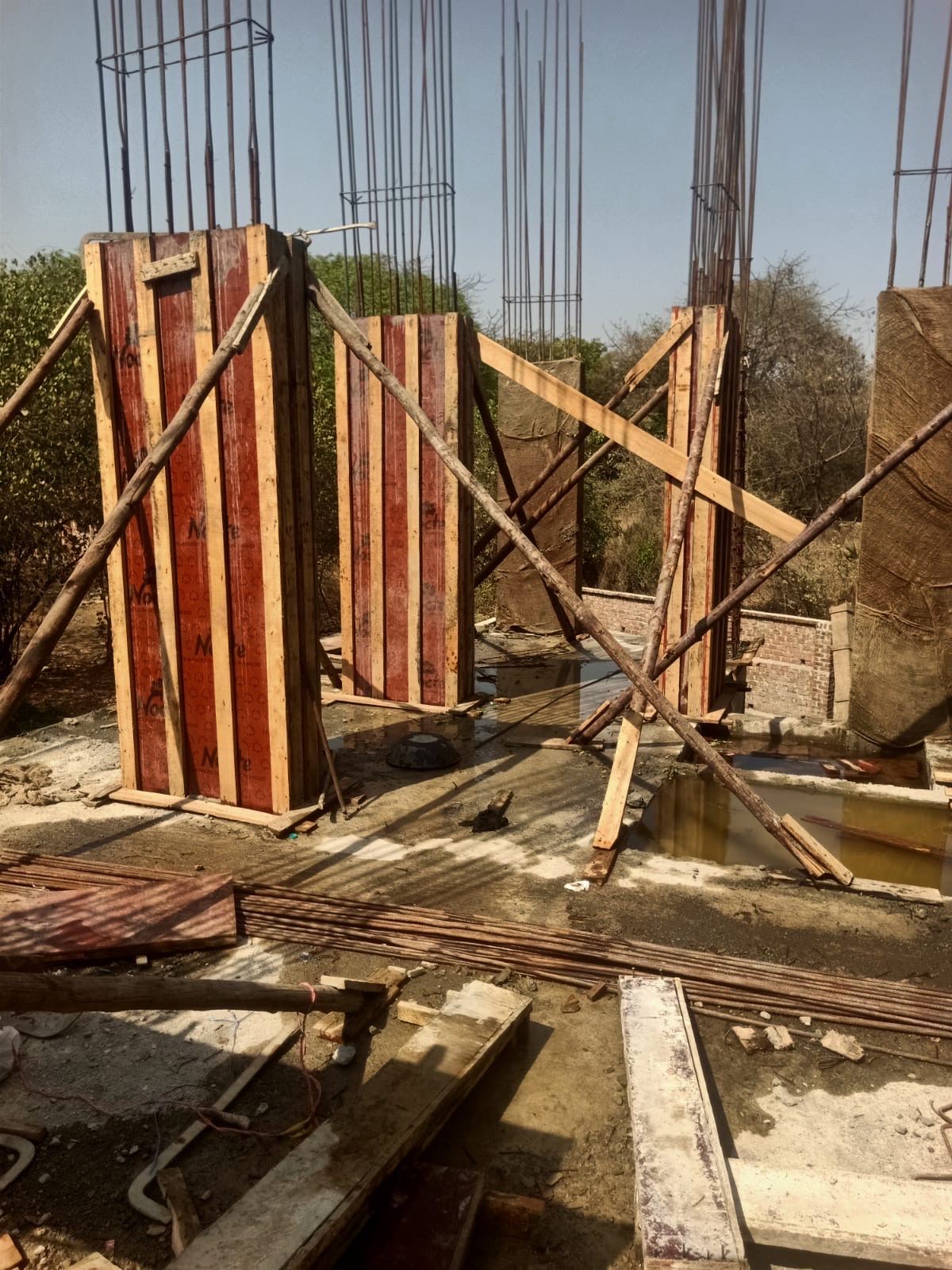

    First floor columns

    Columns for the first floor shuttered on the new slab.

    Site photograph, 2026-05-03Site photograph, 2026-05-06
  10. 31May 2026

    Shuttering the second slab

    Formwork and props over the first floor.

    Site photograph, 2026-05-31
  11. 21Jul 2026

    Second slab cast

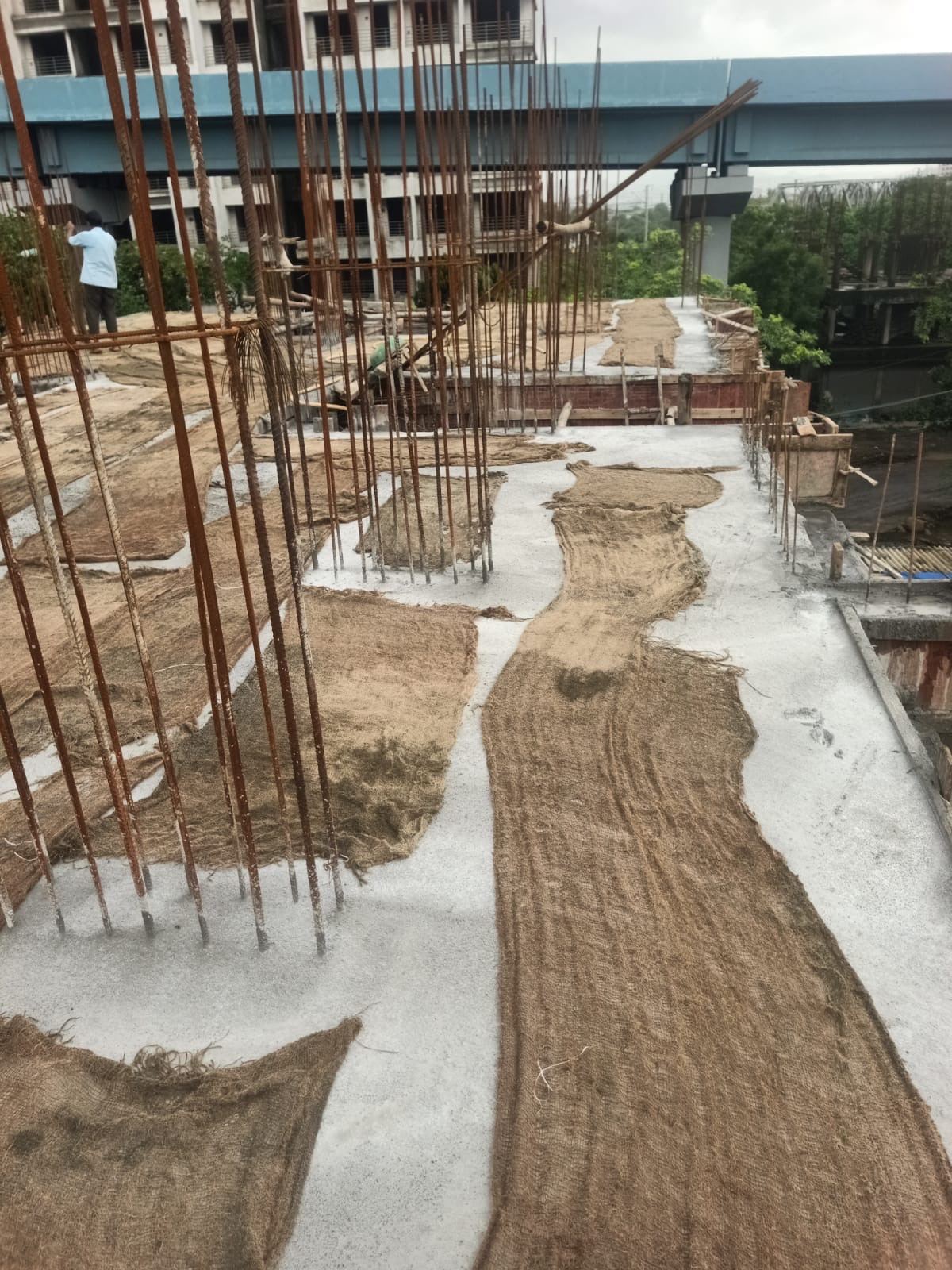

    The second slab cast and kept wet under hessian through the monsoon, with the columns for the next floor rising above it.

    Site photograph, 2026-07-21
  12. Sep2026

    Latest from the site

    Two short videos shared on 5 September 2026: the newest slab and the columns rising above it.

Sheet 04Progress32 photographs · Dec 2025 – Jul 2026Dated by camera

A quiet street,
minutes from everything.

Evergreen House stands on Owali Road in Kamatghar, Bhiwandi, with low-rise neighbours on either side, so the upper floors look over rooftops and trees rather than into other windows.

Railway station
— min tbc
Schools
tbc
Hospital
tbc
Market & daily needs
tbc
Highway access
tbc
Ask for directions to the site
Evergreen House
Illustrative. Owali Road, Kamatghar, Bhiwandi · exact pin to be confirmed

Sheet 05LocationOwali Road, Kamatghar, BhiwandiSite visits by appointment

Kanak Constructions

We build a small number of homes at a time, and stay on site until the last one is handed over.

Evergreen House is built the way we would build for our own families: honest structure, generous light, and no shortcuts hidden behind finishes.

Built, not just developed
Our own engineers run the site every day. What you see in the progress photographs is our team, not a subcontractor's.
Straight numbers
Carpet area is quoted as carpet area. Every figure on this page is either confirmed or marked as still to be confirmed.
One project at a time
Attention is the one thing that cannot be scaled. Evergreen House has all of ours.

Kanak Constructions · Bhiwandi · Established tbc

Talk to us about a home here.

Tell us what you are looking for and we will reply the same working day with plans, pricing and a site-visit slot.

Please tell us your name.
Enter a 10-digit Indian mobile number.
Looking for

Goes straight to the site office, then opens WhatsApp with your message ready. No spam.

Sheet 06EnquireSame working day replySite visits by appointment
